Procurement is the process of buying goods or services. Procurement is often carried out by the process of tendering (inviting many suppliers to respond to a formal request for goods or services), rather than buying products directly from a seller.
It includes invitations to possible suppliers, then through a process of qualification, assessment and evaluation, getting to a preferred supplier.
Properly done, tender management will start with a “procurement trigger” (Purchase request or procurement plan) and include components of meeting management, committee appointments, declarations of interest and specification management.
Tender management is also used by project management organizations to analyze data of proposed & current projects. Project portfolio managers provide forecasting & business analysis when looking to invest in new projects. It starts with obtaining approval and extends into the procurement cycle. By seeing the big picture of how a proposed project will fit into the goals and objectives of the organization, companies can make better decisions on what projects to choose and what initiatives will create the most return.
The objective is a formal, cost effective process, removing subjectivity and increasing governance & transparency.
It involves filtering through (like a funnel which starts off with many and end with few) all suppliers that responded to the invitation through steps of Qualification of supplier as an organization; doing technical analysis on the content of the supplier response, final evaluation looking at pricing and possible costs, ending in a recommended shortlist.
Finally, Tender management concludes with contracts. Contracting officers should have a common thread through the tenders – back to the initial procurement trigger.
They should also set up and maintain complete and up to date records on every aspect of the contract, both to provide a list of actions taken, and to protect the organization’s interests under the contract. This will give an organizational memory of activities and events. |
Consider using the “Most Economically Advantageous Tender” (MEAT) methodology. It means you assess the tenders received using a variety of objective and non-discriminatory criteria linked to the subject matter of the contract to identify the tender which is best value for money.
https://www.gov.uk/government/publications/the-european-union-defence-and-security-public-contracts-regulations-dspcr-2011/dspcr-chapter-16-conducting-the-tendering-exercise
Users can also find Tender management under the Procurement and souring module
Interface is the place at which independent and often unrelated systems meet and act on or communicate with each other. GRC 365 talks to the "outside world". Here is where users connect GRC to external independent systems.

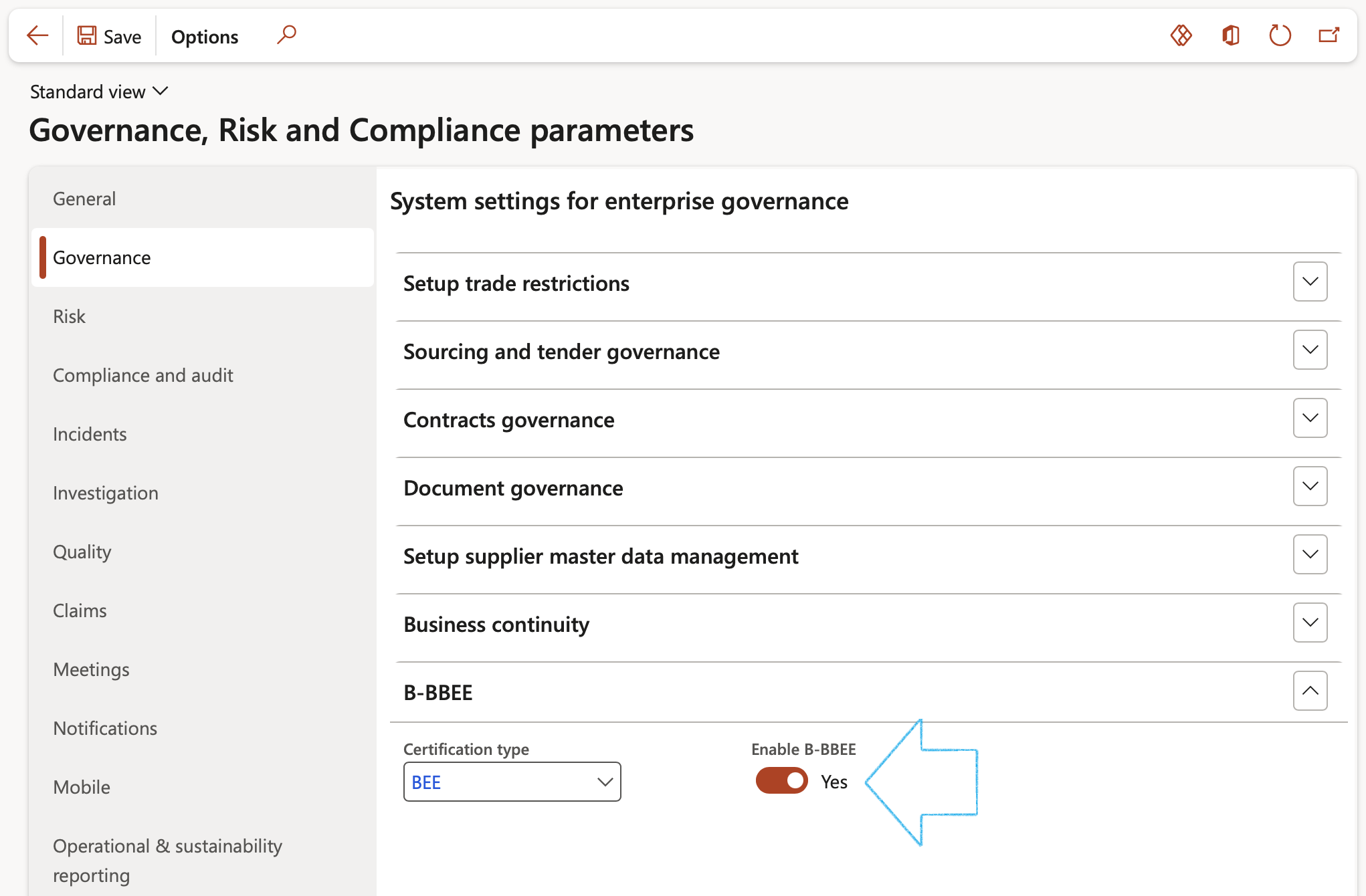

Go to: GRC > Setup > GRC parameters
Before a tender is issued, a pre-qualification process is conducted to identify and shortlist potential suppliers/vendors. The prequalification process assesses various criteria, such as technical expertise, financial stability, past performance, and other relevant qualifications. Only those who successfully meet the pre qualification criteria are invited to participate in the subsequent tendering stage. In GRC 365 pre-qualification is applied on the prospective vendors that registered to become vendors.
Go to: GRC > Setup > GRC parameters
Go to: GRC > Setup > GRC parameters
Users can auto create a contract on the acceptance/awarding of a bid. In this scenario it will be useful to use the RFQ number in the name of the contract. To enable this. Under the Contracts governance Fast tab:
Go to: Procurement and sourcing > Setup > Procurement and sourcing parameters
Allow vendor questions: Enables or disables vendor questions for RFQ cases.
Default direct response: When you reply to a question, you can choose to reply to all vendors who received the RFQ or to reply only to the specific vendor who submitted the question. You may choose this option each time you reply, but this setting controls the default. If you usually reply to all vendors, set this to No. If you usually reply to individual vendors, set this to Yes.

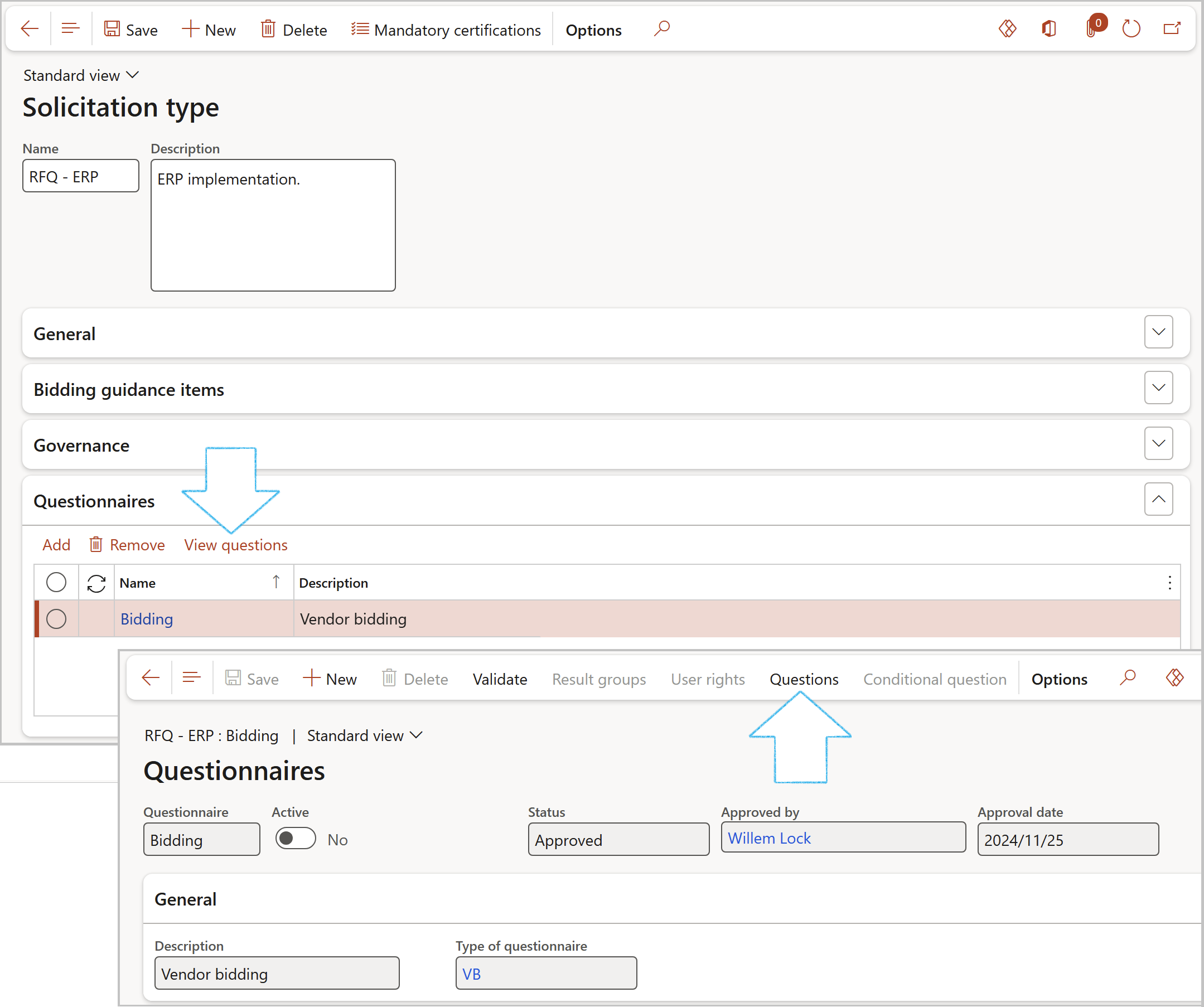

Task lists are useful for users that prefer having a list of steps to follow when doing spesific tasks. For example a task list for internal procurement users to guide buyers on a proces to follow when managing replies from bidders. Created task lists are displayed on the home page of Dynamics 365 with color coded due and over due border.

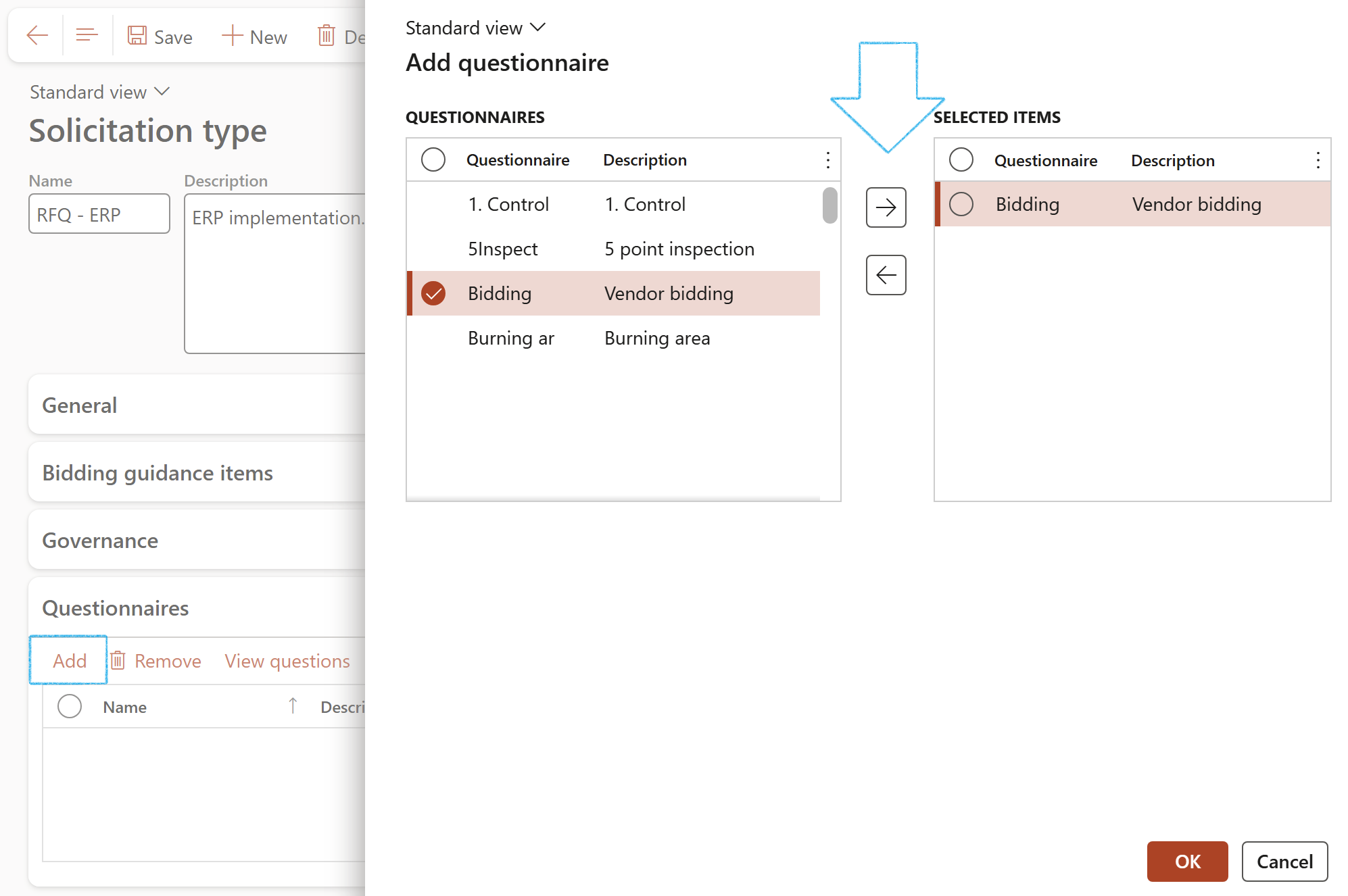

A Task list is selected on the Solicitation type under the Governance Fast tab
Go to: Human resources > Task management > Generic checklists
A Process is selected on the Procurement plan under the Planning and approvals Fast tab. This in turn will create an overall process for the users. With mark as "complete" options.
Go to: GRC > Setup > Process and activity

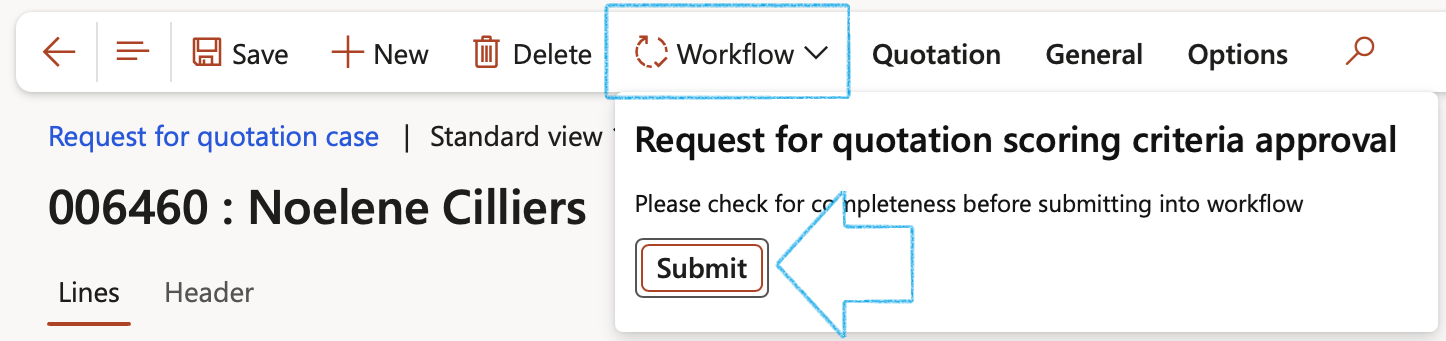

Meetings are formally scheduled and recorded in GRC 365. With a list of people invited and record of those that attended. In the Tender events it is used for Briefing sessions and more.
Go to: GRC > Meetings > Setup for meetings > Meeting types

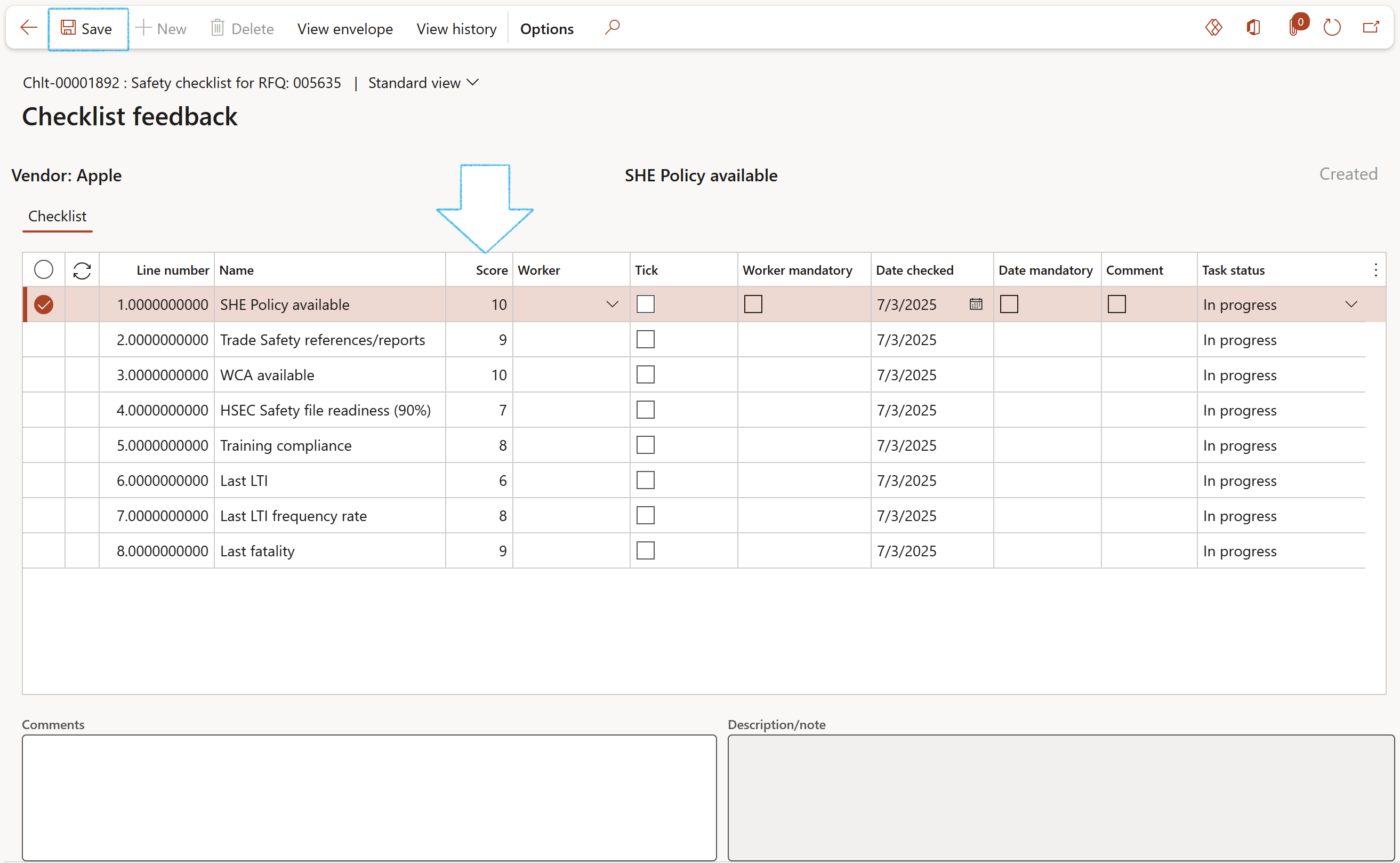

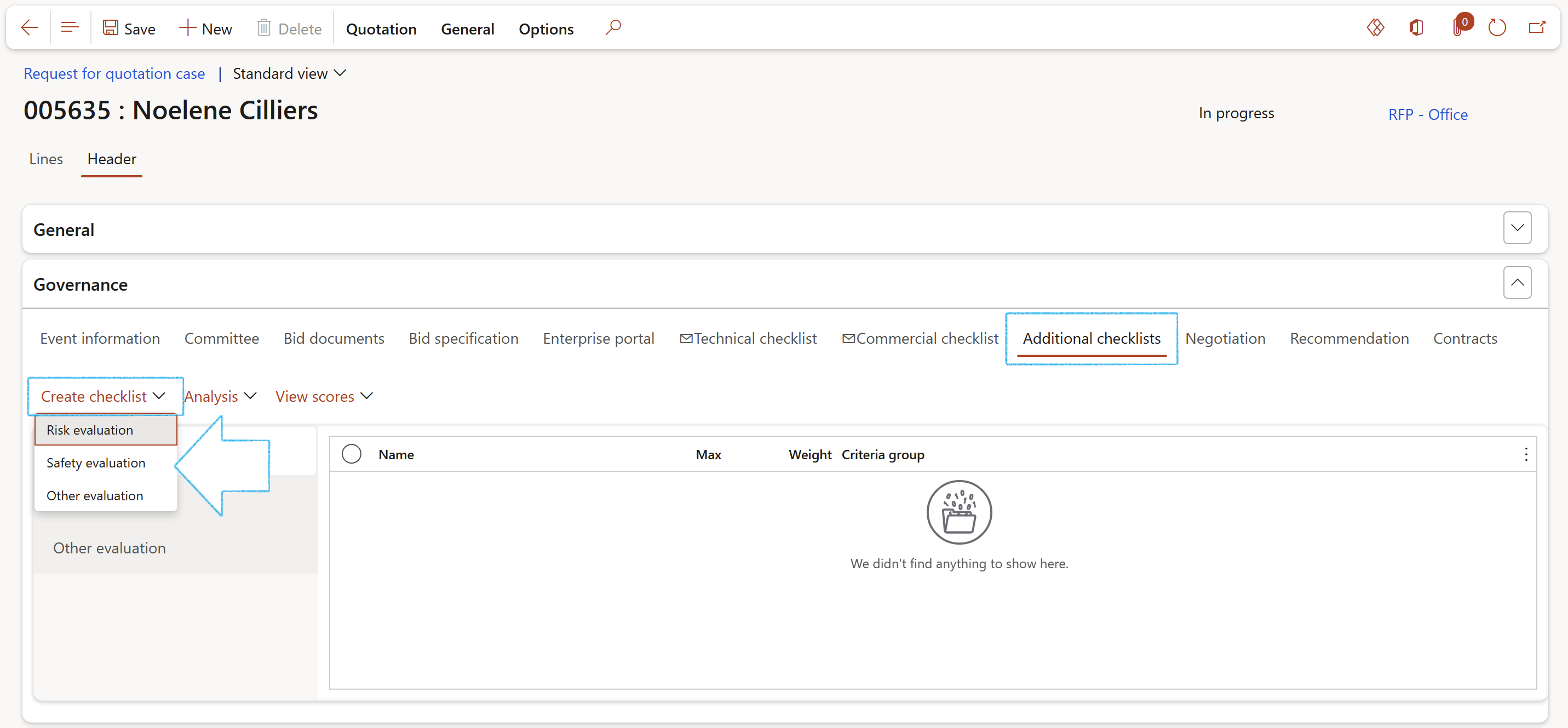

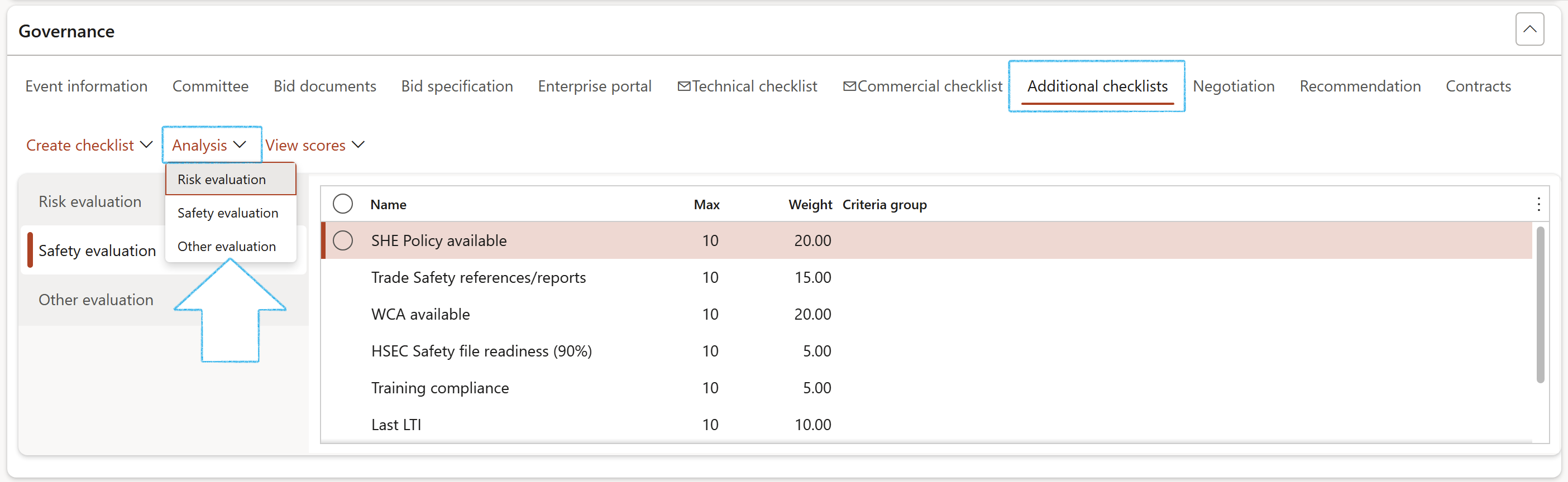

The Technical and Commercial checklists, as well as the Pre-qualification check lists are created based on job plans (and scoring criteria) which are setup on this form.
Go to: GRC > Setup > Job plan
For some tender processes, a zero checklist line can be used because they will not be part of the scoring mechanism.

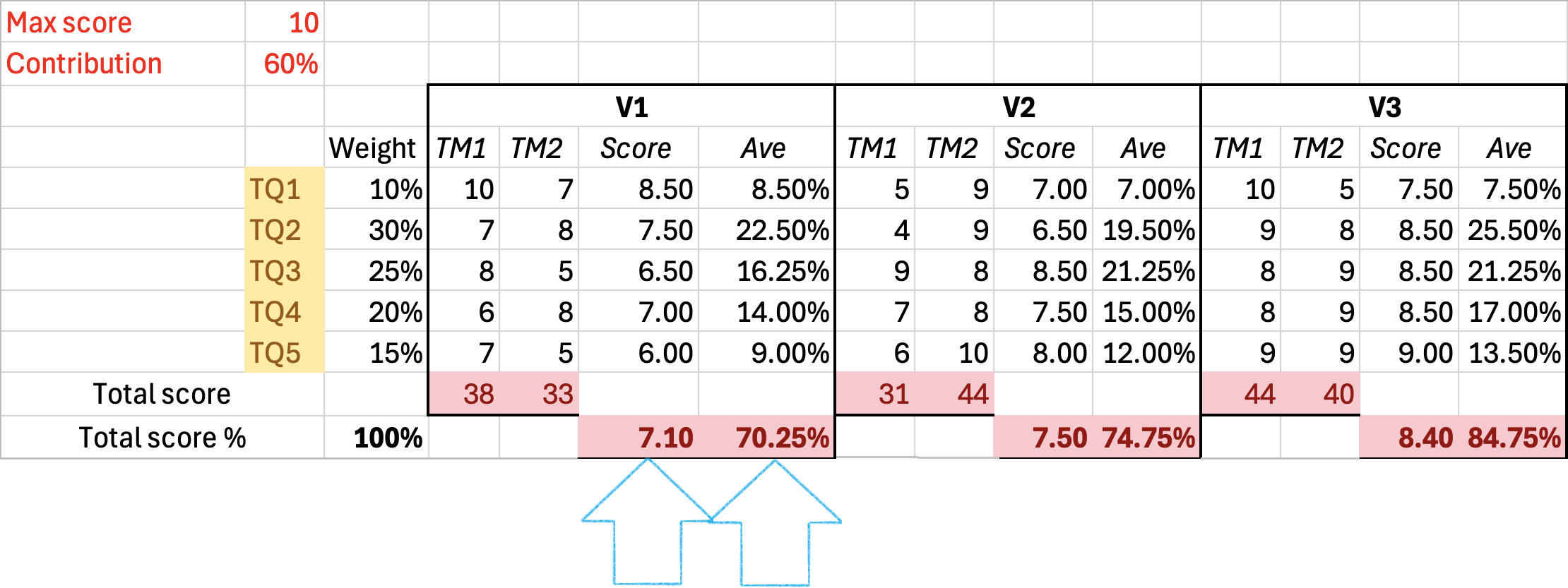

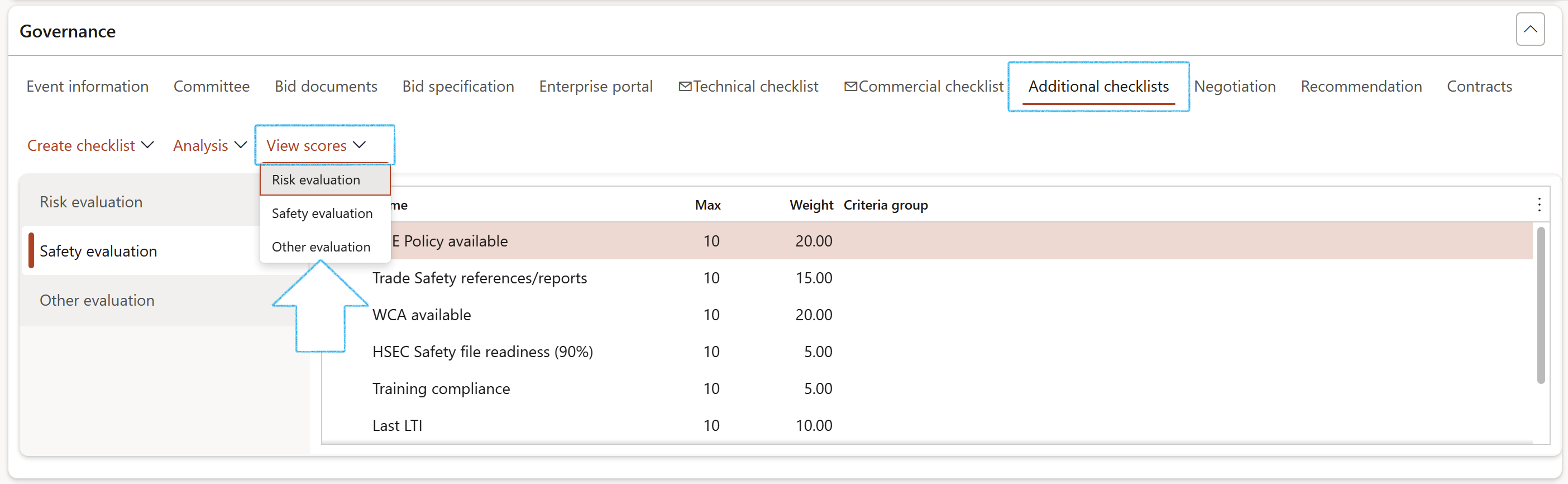

For enhanced scoring, additional fields exist on the Scoring criteria form
Go to: GRC > Governance > Setup for governance > Scoring method
Note that both Job plans and Scoring methods configurations are required for the creation and scoring of Checklists
For certain actions (such as a Bid waivers) GRC can provide questions to users to answer, thus justifing the action.
Go to: GRC > Setup > GRC actions and questions
The Question text is the text that is displayed on the Bid waiver dialogue.
A question must have an Answer type:
The response to the question is set by the Negative outcome setting:
Go to: GRC > Setup > GRC action and question groups

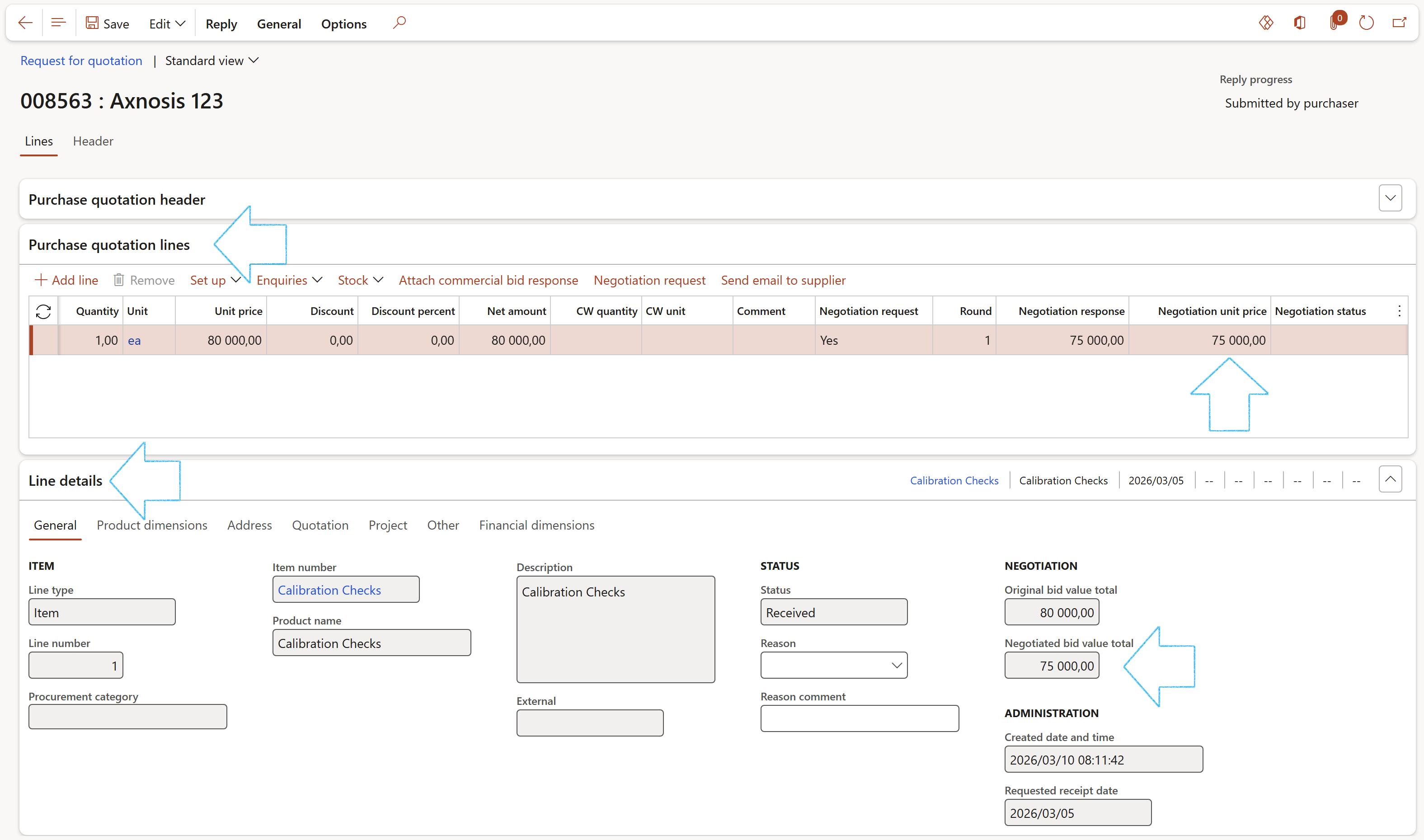

The selections made under the Lines Fast tab, will determine how calculations are done, and which columns will be displayed on the Evaluation dialog, opened from the RFQ.
Go to: GRC > Governance > Setup for governance > Evaluation setup

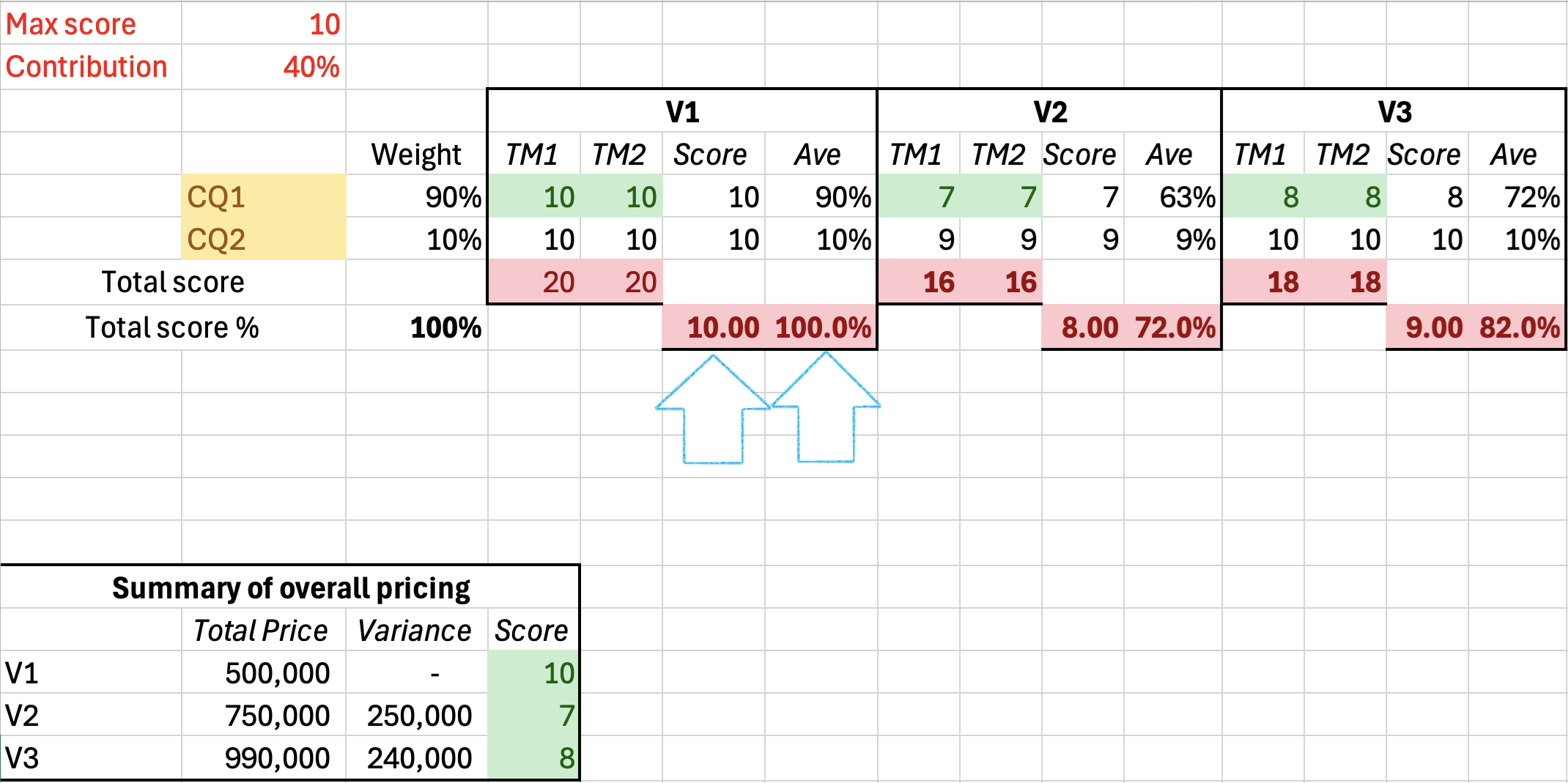

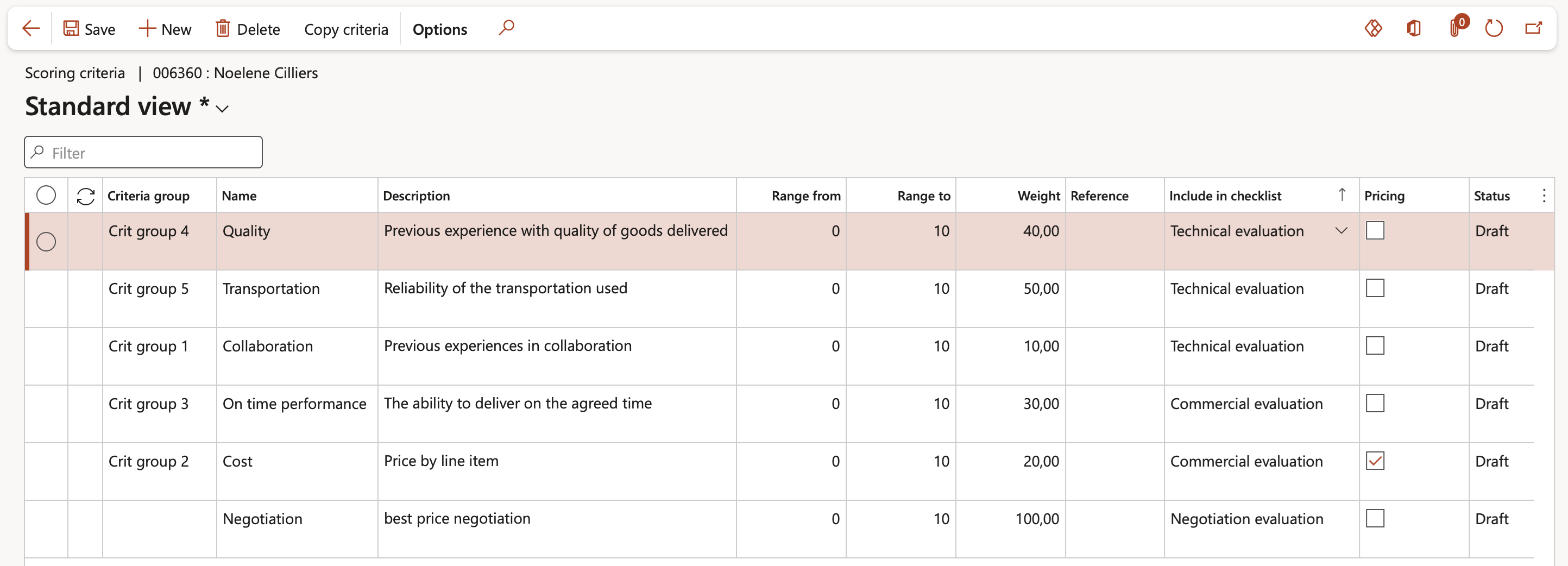

Evaluation criteria determine the distribution of weight between the average commercial score and the average technical score in a bid to calculate the combined score. For example, with the evaluation criteria 80/20, the average commercial score contributes 80% of the combined score, while the average technical score contributes 20% of the combined score.
Tick the Hide tick box to hide columns that should not be displayed on the Evaluation dialog
Explanations for the values selected in the Display column:
To copy an Evaluation setup:
The Evaluation criteria, as well as all the lines will be copied to the new Evaluation setup
Solicitation is the act of requesting. The objective of solicitation is to prepare and issue a solicitation to ensure that all qualified bidders are given the opportunity to compete for a contract. For Advance procurement this object/form is where most of the rules are specified. Default values and rules spesified here are carried over and applied to Procurement plans and RFQs.
Go to: GRC > Governance > Setup for governance > Solicitation type
Bid teams are explained below in Step 13.
- The Job plan that is selected in the Qualification job plan field, will be displayed on the RFQ, Governance Fast tab, Qualification checklist Index tab
- The Job plan that is selected in the Technical job plan field, will be displayed on the RFQ, Governance Fast tab, Technical checklist Index tab
- On Awarding of the bid, the RFQ will create the purchase agreement with an effective date of Today + “7”
- When selecting the Baseline contract, make sure that the clauses that have to be copied to the contract when the RFQ is awarded, are ticked to be copied
- A Default item can be selected for RFQ lines. When users creates an RFQ; a line is created for them using this value.
The purchase agreement classification allows you to control the administrative information that is available on purchase agreements. For example, it allows workflow to be used or not.
Inside the general tab, there are several fields available which are relevant to specific businesses. Some of them are visible when public sector configuration key is enabled. Others needs to be enabled in feature management (Purchase agreement responsible party, Purchase agreement responsible status, Purchase agreement matching policy).
Go to: GRC > Governance > Setup for governance > Purchase agreement classification
Under the General Fast tab:
Under the Governance Fast tab:

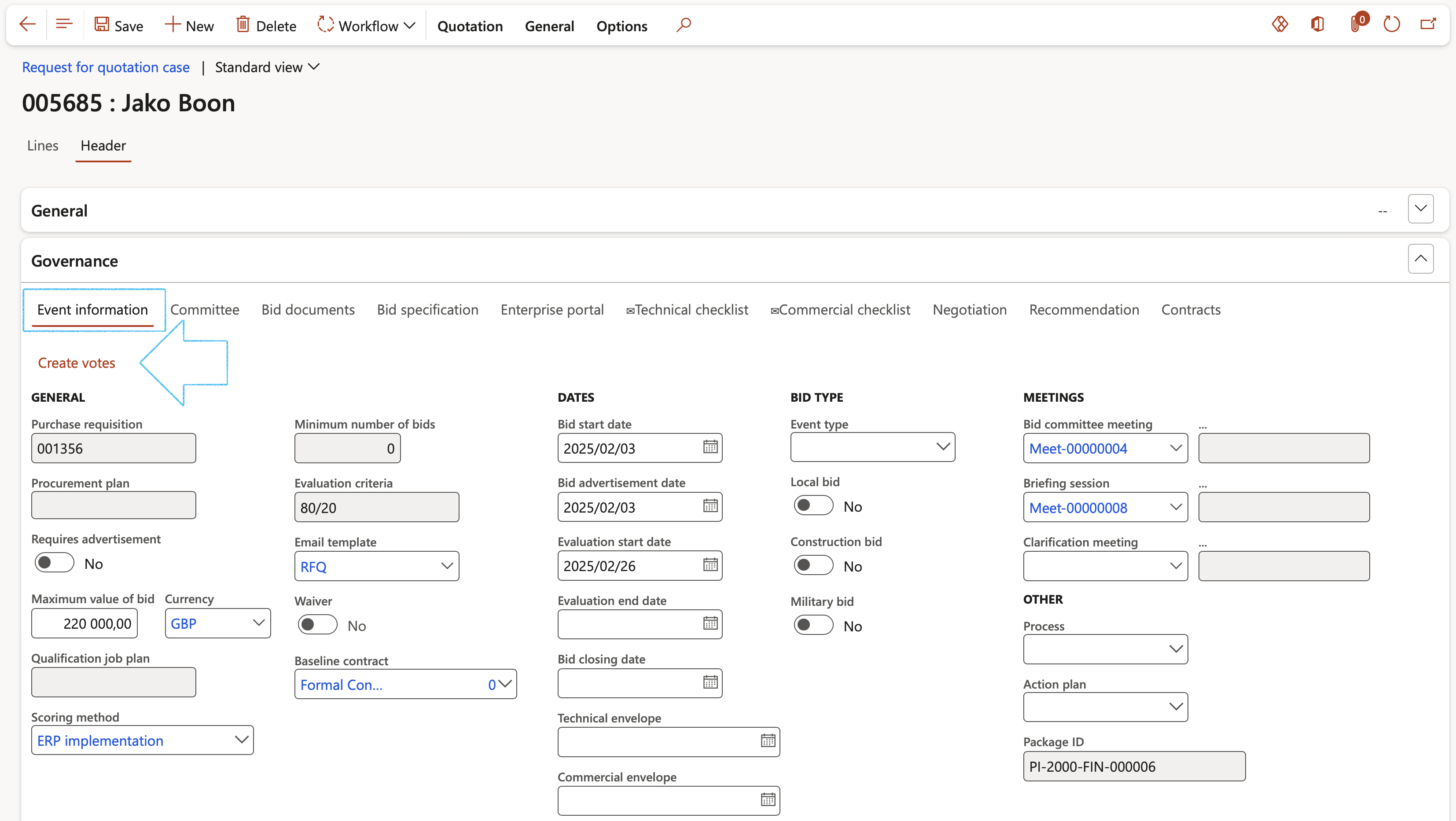

Before launching the tender event, the buyers should satisfy themselves that all planning, budget analyses and exercises have come to a satisfactory conclusion. It is good practice to develop a check list and confirm/check that all relevant conditions of preparation and structuring are met. In addition an Approval authority matrix should be defined. This is useful for Workflow as well reporting inside the tender evaluation report (TER).
Go to: GRC > Governance > Setup for governance > Approval authority
The approval authority is also used in the gift register. Users define thresholds (per department/cost centre etc.) for gifts received and subsequent approval based on said threshold value.
A typical proses
Tender management is all about obtaining approval of doing a new project and starting a program. It begins with a plan and extends into the procurement cycle and ends in formal project accounting and management. The last mentioned is not covered in this document.

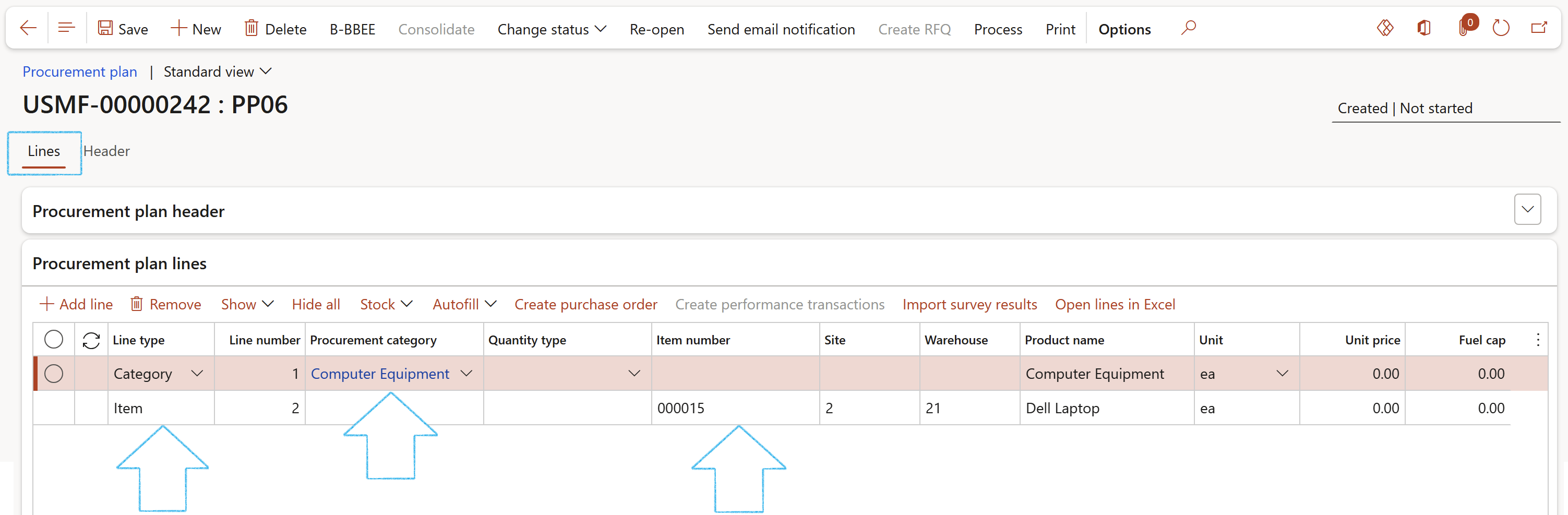

Procurement planning is the process of identifying and consolidating requirements and determining the timeframes for the procurement steps; with the aim of sourcing quality suppliers, services and items.
A good procurement plan will describe the process in the identification and selection of suppliers/contractors/consultants.
GRC aids towards this by adding some functions to RFQ and Projects.
Go to: GRC > Governance > Tender management > All procurement plans
Columns on the Procurement plan list page:
Number | Legal entity | Parent |
Ref number | Date created | Currency |
Reporting status | Estimated value (incl. all taxes) | Project description |
Project | Programme (Business unit) | Specification submission |
Planned method of procurement | Evaluation criteria | Envisaged date of bid award |
Envisaged date of advertisement | Envisaged closing date of bid | Planned currency range |
Envisaged evaluation start date | Envisaged evaluation end date | Planned award year |
Planned award quarter | PP additions per quarter | Stage of procurement |
Actual award quarter | Actual award year | Budget register entry |
Currency value ranges | RFQ case number |
In the Action pane, click on the New button
Only members of the Approval team can re-open a procurement plan
The Responsible worker’s name will be displayed according to the selection made on the parameters (Step 2 above)
An email can be sent to the selected worker in the following fields if they have a Primary email address: Project manager and the Responsible person
The value displayed in the Expense budget field comes from the Expense total field under the Budget details Fast tab
To view the details of the process, click on the Process button in the Action pane
The package ID will be displayed on the linked RFQ under the Governance Fast tab, and subsequently on the Contract
A Top-level procurement plan is a procurement plan with one or more Child procurement plans linked to it.
To indicate that this is the Top-level procurement plan:
The following is displayed for each Child procurement plan in the Related information pane:
By clicking on the Number of a Child procurement plan, the user can jump to the child plan.
If you want to go back to the Top procurement plan from the child, click on the back arrow (top left-hand side of the form)
Certain enterprises need to consolidate procurement plans across multiple legal entities. GRC allows users to link different plans to a “top level” (parent) plan and calculate the consolidated plan amount from the child plans.
The approvals and RFQ process can start on the parent or child level.
The Consolidate button:
An email notification will be sent to the Responsible person selected under the General Fast tab
Placeholders | Field on form |
---|---|
%ReferenceNumber % %DateCreated% %ProjectDescription% %PlannedMethodOfProcurement% %EstimatedValue% %urlLink% |
Reference number Date created Project description Planned method of procurement Estimated value URL |

Click on the link below for instructions on how to setup email templates in D365:
https://learn.microsoft.com/en-us/dynamics365/commerce/email-templates-transactions
The Procurement Plan is an annual document which defines the products and services that a Public Body will obtain from external suppliers. A sound procurement plan helps a Procuring Entity to define their procurement requirements and to decide where and when to procure. It normally is used for high value service, items and/or projects.
The procurement plan will be in accordance with the entities’ approved budget for the Year. Procurement plans can be revised and updated during the course of the financial year, with regards to new arising projects, which was not initially listed
- Only members of the selected Approval team can approve the procurement plan.
- If no team is selected, any user can approve the procurement plan.
- Only an Approved Project and program portfolio line can be used to create an RFQ
Project and program portfolio statuses:
Status | Rules |
---|---|
Created: |
|
Approved: |
|
Likely to award: |
|
Award: |
|
Defer: |
|
Withdraw: |
|

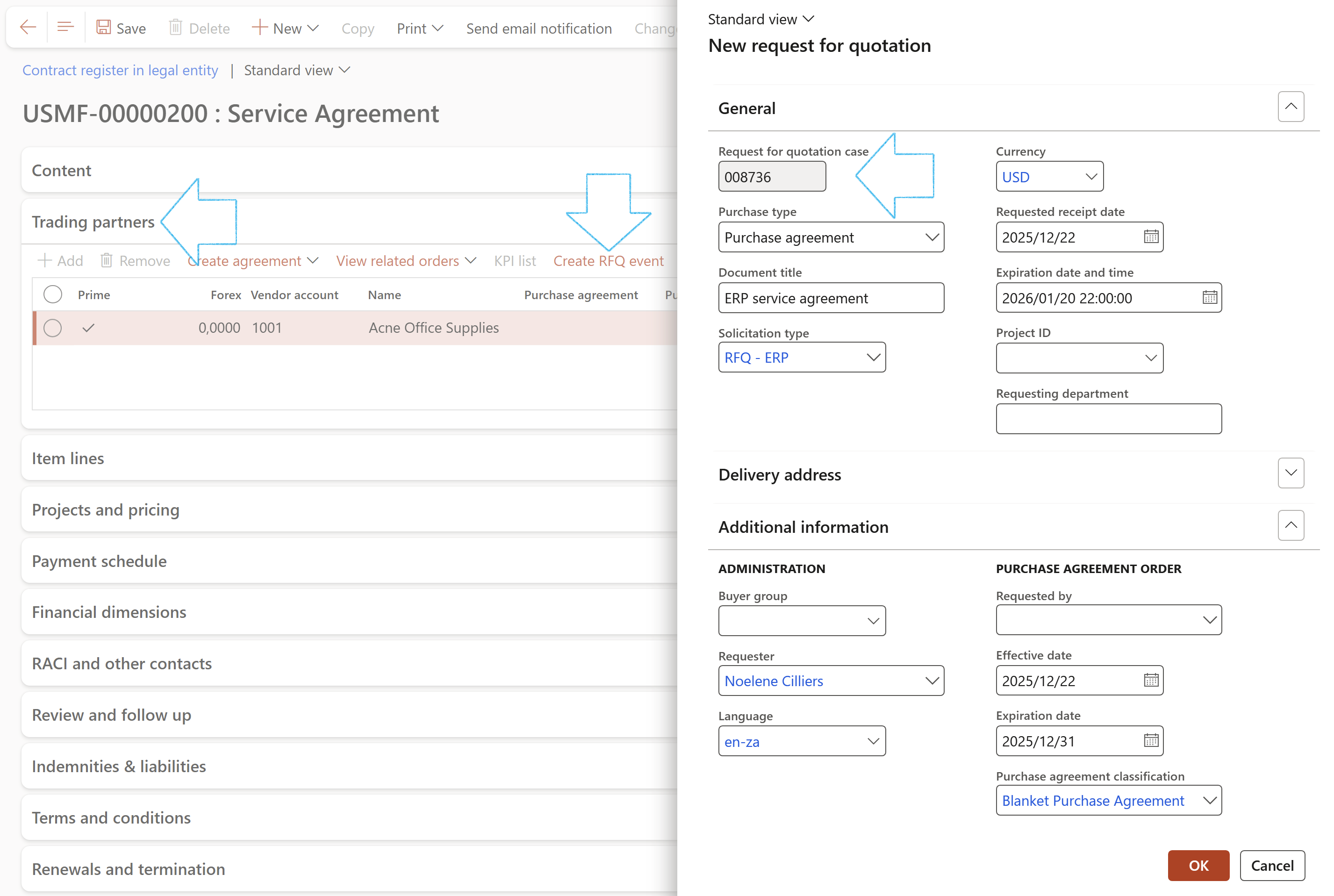

Alternatively (do not use a procurement plan) users can initiate a bid from a Purchase requisition
Purchase requisitions are first filled out by an employee who sees the need for a product or a service. The employee fills in all the details, including the price, suggested vendor, and the specifics of the goods or services. The document is then sent to the purchasing department for approval.
Go to: Procurement and sourcing > Purchase requisitions > All purchase requisitions
The package ID will be displayed on the linked RFQ under the Governance Fast tab, and subsequently on the Contract
To view your notification, log into D365
The information from the Procurement plan line will populate the fields on the New request for quotation dialog
- The status of the Procurement plan has to be Approved
- A purchase agreement will automatically be created when Purchase agreement is selected in the Purchase type field
On the Procurement plan header view
The newly created RFQ is displayed here. In addition the fields in this Fast tab will be updated as the detail on the RFQ is changed.

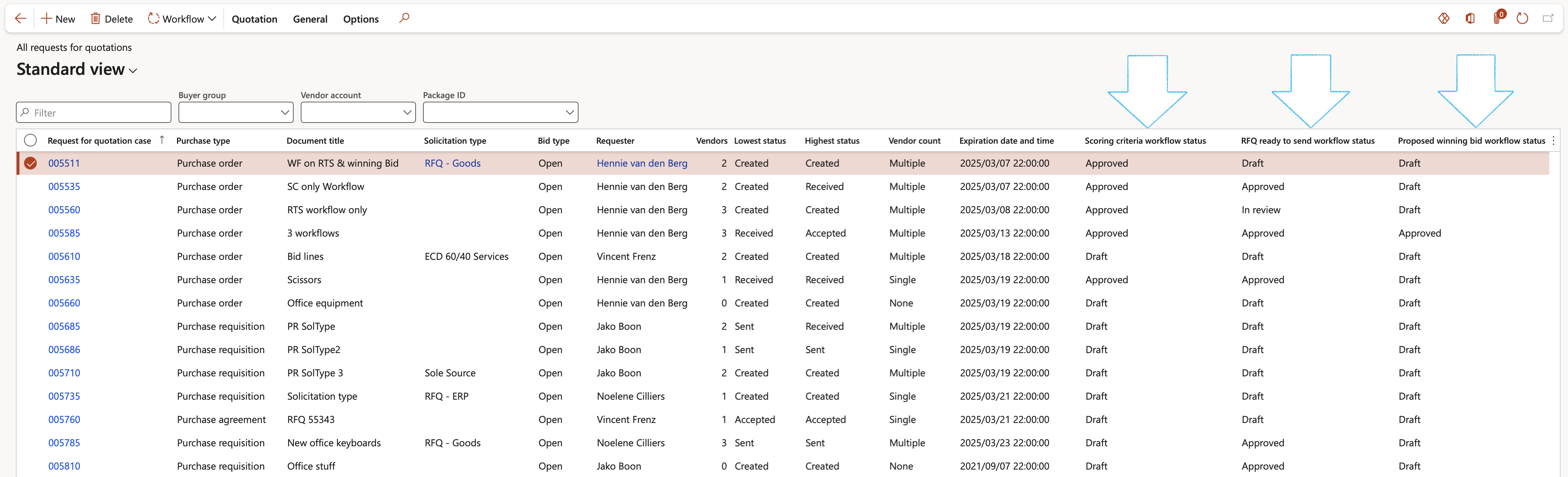

Go to: GRC > Governance > Tender management > All requests for quotations

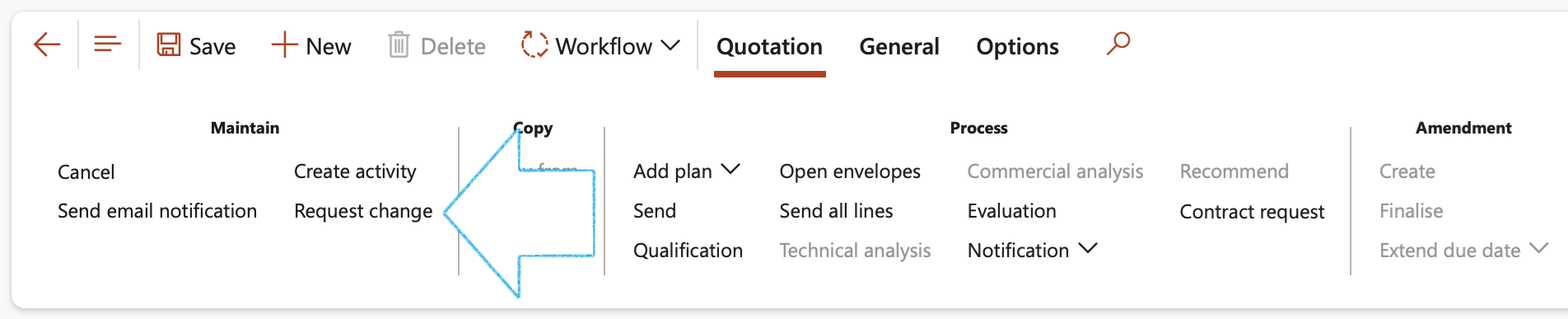

When the Solicitation type is changed on the RFQ, some values that came from the original Solicitation type might now be different on the RFQ. A dialog will come up giving the user the option to apply changes to the following:
Go to: GRC > Governance > Tender management > All requests for quotations
After user selected a briefing session, if suppliers exist on the selected Briefing session, a pop-up will prompt the user to confirm that these suppliers can be copied to the RFQ
Detail from the Procurement plan is visable under the Buisness information Index tab.
Additional under the Governance Fast tab:
- It is required by law (think Government tenders) for RFQs to be made public via advertisement. To this end an identifier is available on the header under the Business information Index tab
- In addition, the value of RFQs can be limited by using the Maximum value of bid field.
On the RFQ header: If a Baseline contract is selected where the AP enforce slidewr is on Yes, and a Purcahse agreement classification is selected under the General Fast tab, where the Contract value enforced slider set to No, a message will pop up to notify the user.

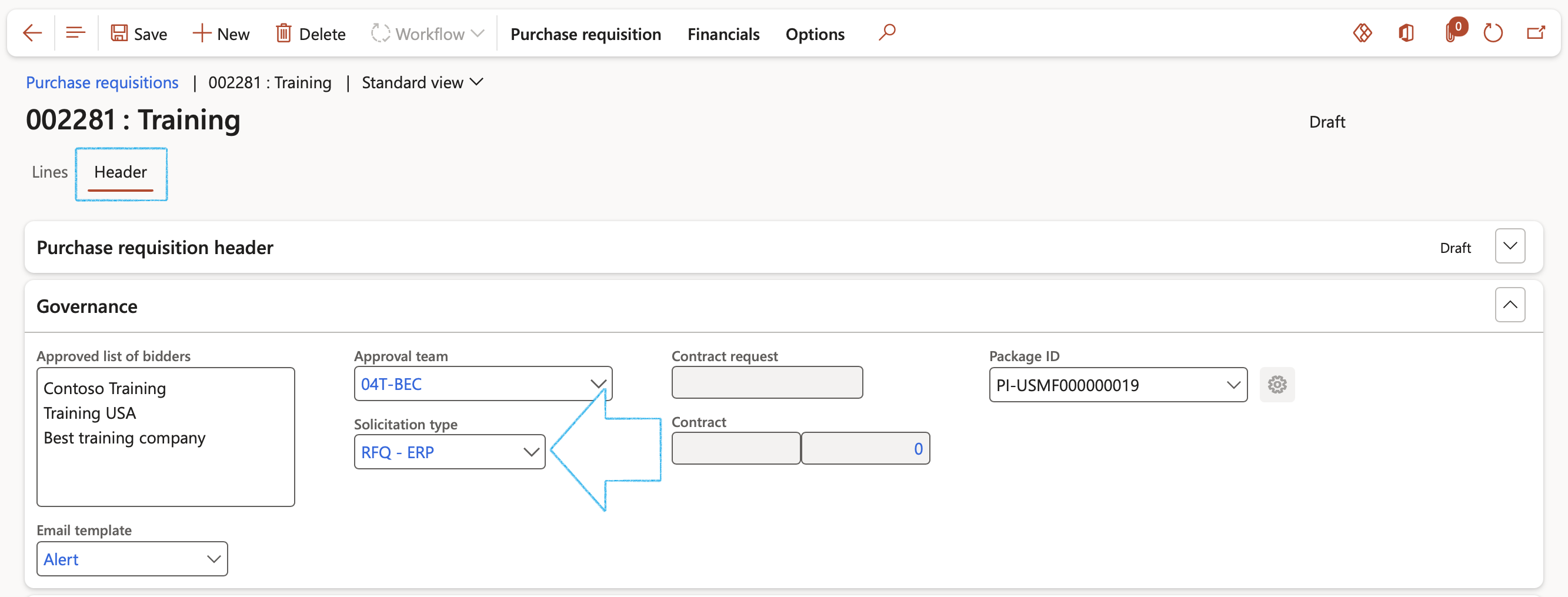

It might be required that an RFQ is created while the Procurement plan has not yet been approved. Then, once the Procurement plan is approved, for the RFQ should be linked to the approved Procurement plan.
Go to: GRC > Governance > Tender management > All requests for quotations
Only the following Procurement plans will be on the dropdown list:
- Procurement plans that do not have an RFQ linked
- Approved procurement plans
- Procurement plans where the Solicitation type is the same as on the RFQ
It is important to choose the right evaluation team for your procurement bids. Small groups work better, bringing a balanced perspective to the scoring process. Ideally organisations should include a combination of financial, technical, and purchasing expertise within a bid team. Properly done, bid teams will ensure proper segragation of duties and proper governance.

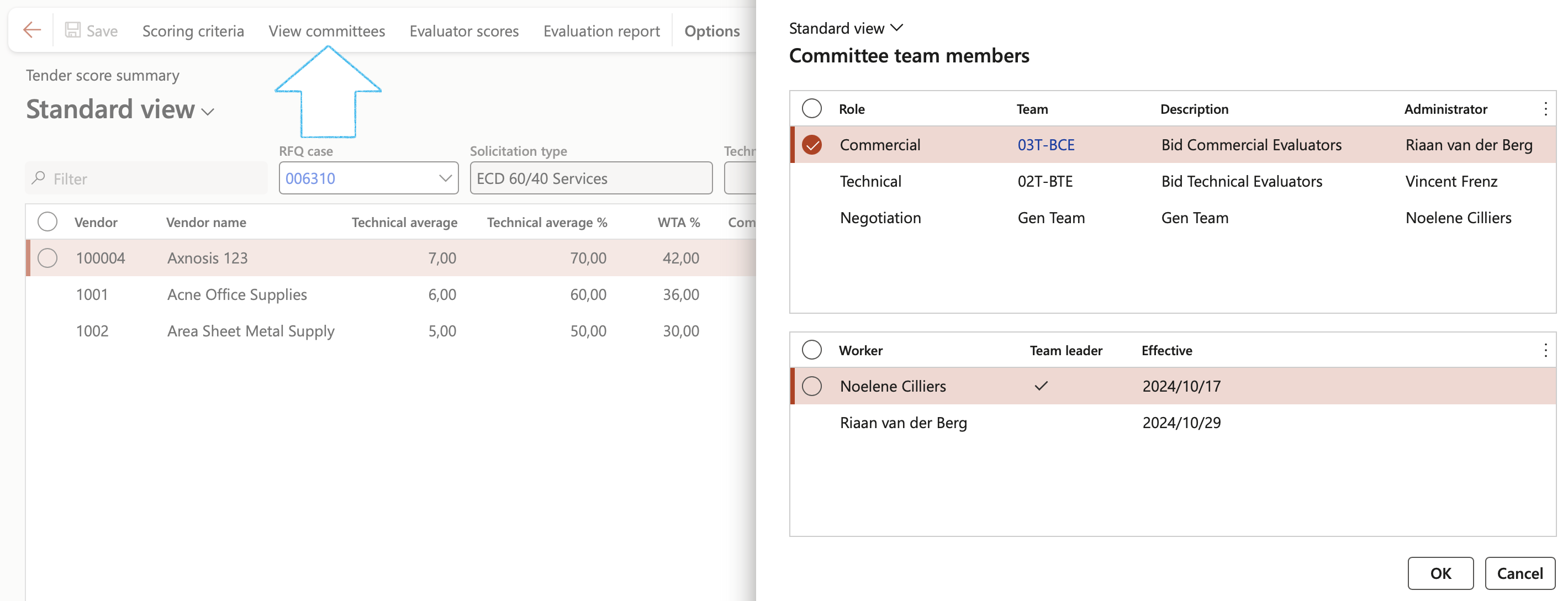

Inside GRC, a Team is a collection of workers (and system users) who are getting together for a temporary assignment. An example is a bid adjudication committee.
Go to: GRC > Governance > Setup for governance > Teams
Go to: GRC > Governance > Setup for governance > Teams
The Add team members form will open
You can filter the list of people by name or by skill and add them in bulk
Bid committees are crucial to mitigate the risk of corruption and fraud. Different roles are assigned to these committees. One such example would be the bid evaluation committee (BEC). They are responsible for the evaluation of bids submitted in response to a public invitation for bids.

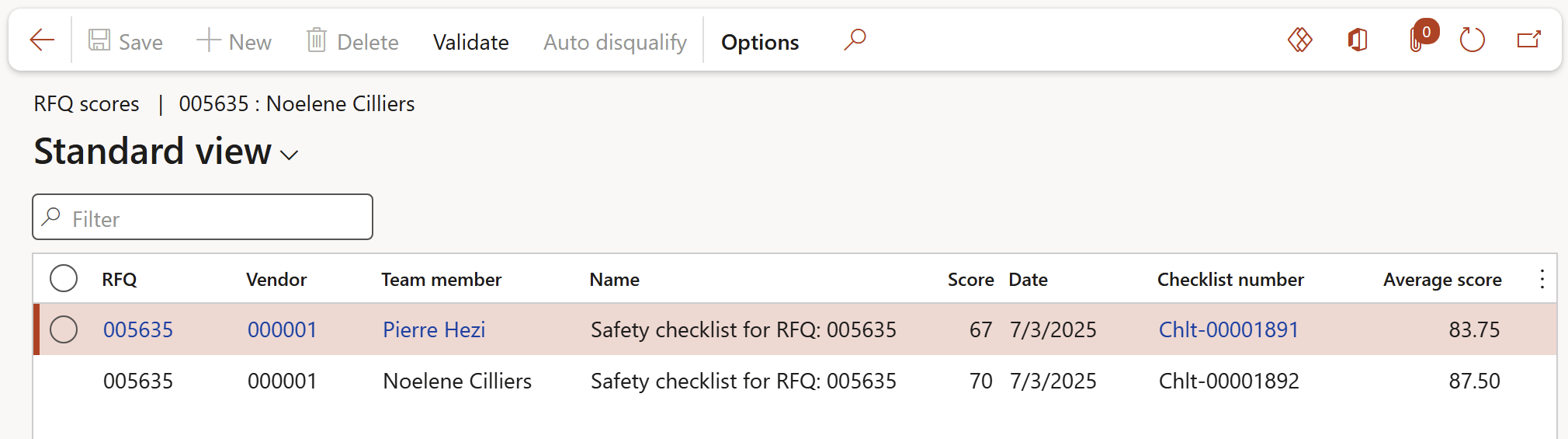

The Scoring role ensures segregation of duties when the Scoring criteria button is clicked on the Action pane.

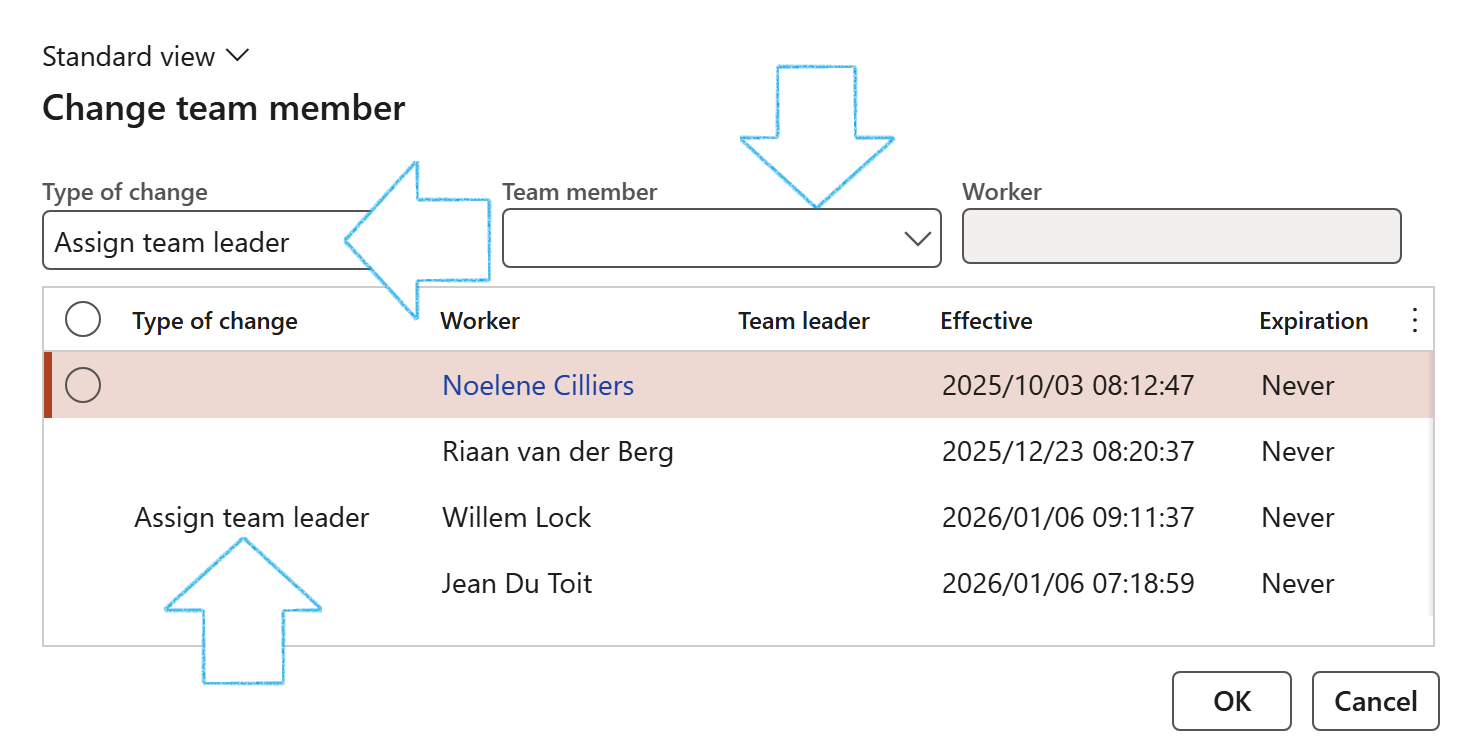

There might be a scenario where team/committee members change during the tender process. To change team members from the RFQ, follow the steps below.
The Teams setup form will be updated with all changes made to a team on the Change team member dialog
Employees need to declare any actual or potential conflict of interest. It is the responsibility of all staff to ensure that they are not placed in a position which risks, or appears to risk, conflict between their private interests and their company duties.
Team members will be able to do a declaration of interest from the Request for quotation form under the Committee Index tab.
Go to: GRC > Governance > Tender management > All requests for quotations

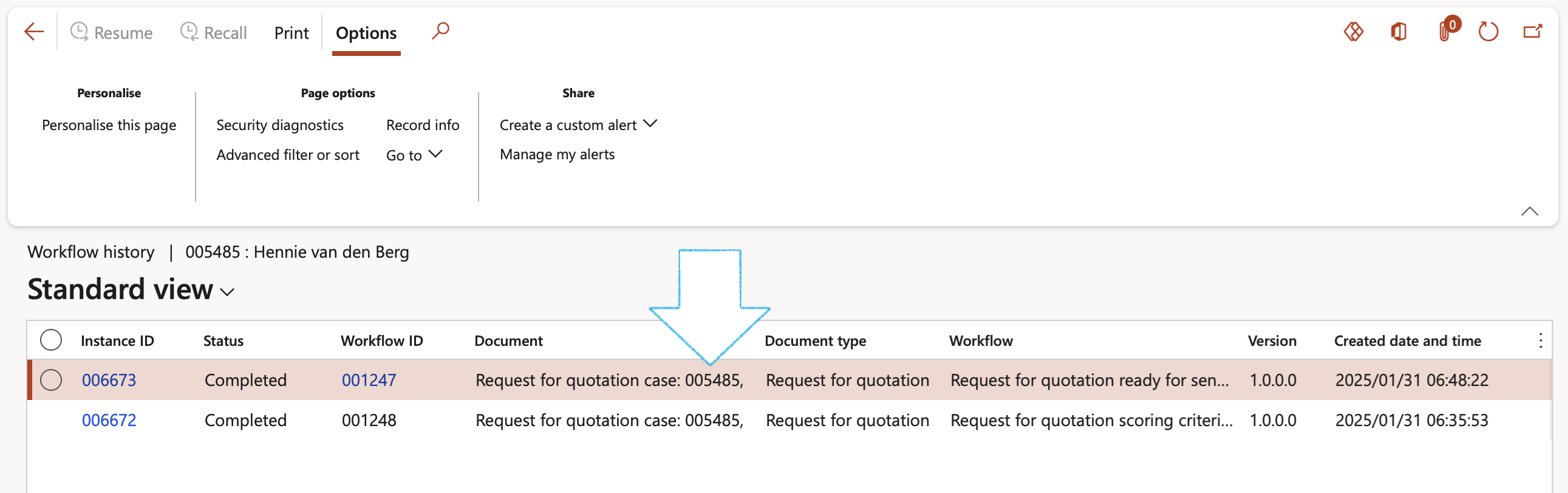

The Declaration of interest status will now be Complete
- When users click on the Do declaration of interest button, all members in the team will be created as records in the Declaration of interest register
- It is assumed that all members have done a DOI
- If a member did not do a DOI, then the record for that member can be deleted
- Repeat this step of clicking on the Do declaration of interest button to do a complete DOI
A Document pack is used to group multiple documents together. These documents normally support tender and contracting activities. Thus, when a set of templates is needed for a tender, they can be referenced on the RFQ by using a Document pack. Additionally, a list of recipients can also be added to the pack. This is useful when needing to send a set of documents to a bid committee.
Go to: GRC > Governance > Setup for governance > Document pack
The link between the Document pack and the Related documents is created on the Specifications form.
Also note the URL reference is most likely to a SharePoint site/document library.
Only approved packs can be used on the tender event (RFQ).
Bid specification is all about the standards or qualities which must be met before a contract will be awarded, and any terms which the buyer has set as a condition precedent to the awarding of a contract. The bid specification normally forms the backbone of the technical evaluation.

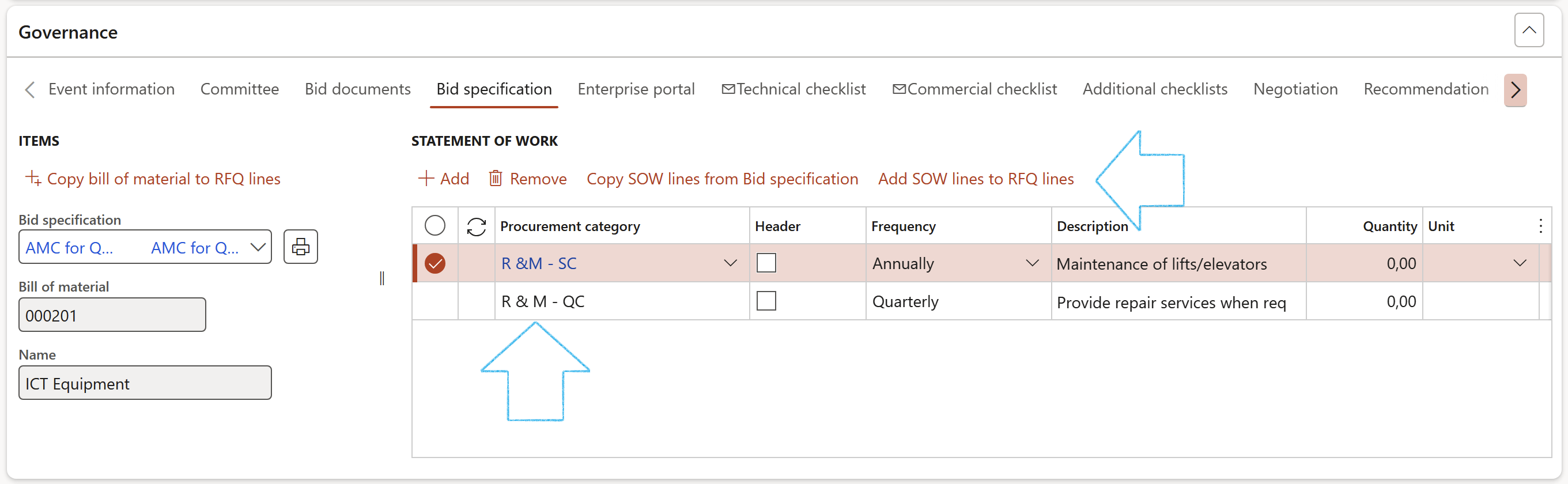

Users can create a detailed specification for inclusion in the RFQ. Only documents of type Specification are available for selection on the RFQ.
Go to: GRC > Governance > Tender management > Specifications
On the New specification dialog:
Only members of the Approval team can approve the specification
Dynamics 365 contracts and tender management includes the ability for users to create, maintain and use the bid specification inside Dynamics 365. Down stream users can (and should) use the bid specification to create the bid/rfq lines (items).

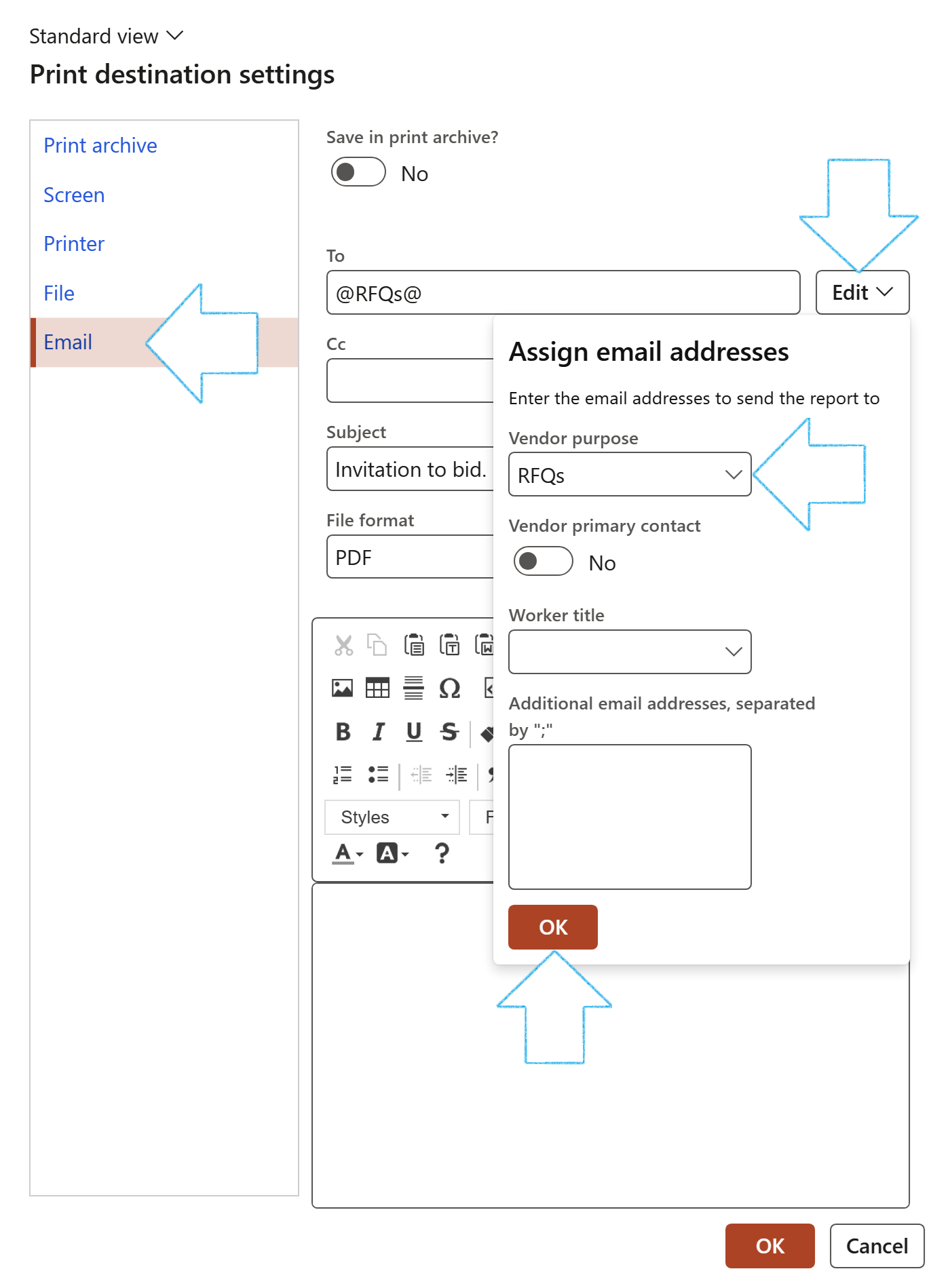

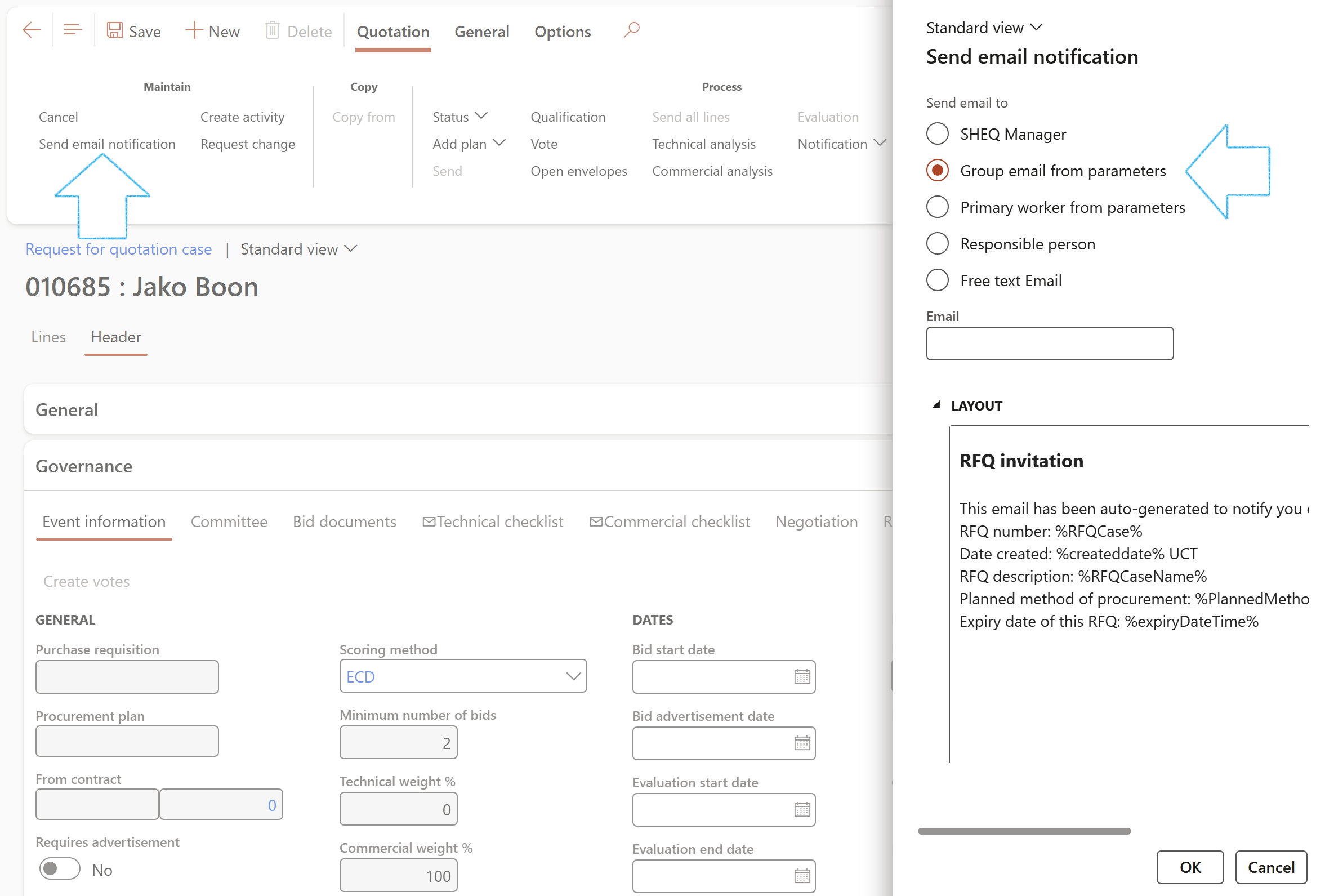

An email notification can be sent to selected stakeholders regarding the specification.
An email notification will be sent to the selected stakeholders
Placeholder mappings | Field on form |
---|---|
%ReferenceNumber % %DateCreated% %ProjectDescription% %PlannedMethodOfProcurement % %EstimatedValue% %urlLink% %Requester% %ClosingDate% %BusinessJustification% |
Reference number Date created Project description Planned method of procurement Estimated value URL Responsible person Envisaged closing date of bid Business justification |

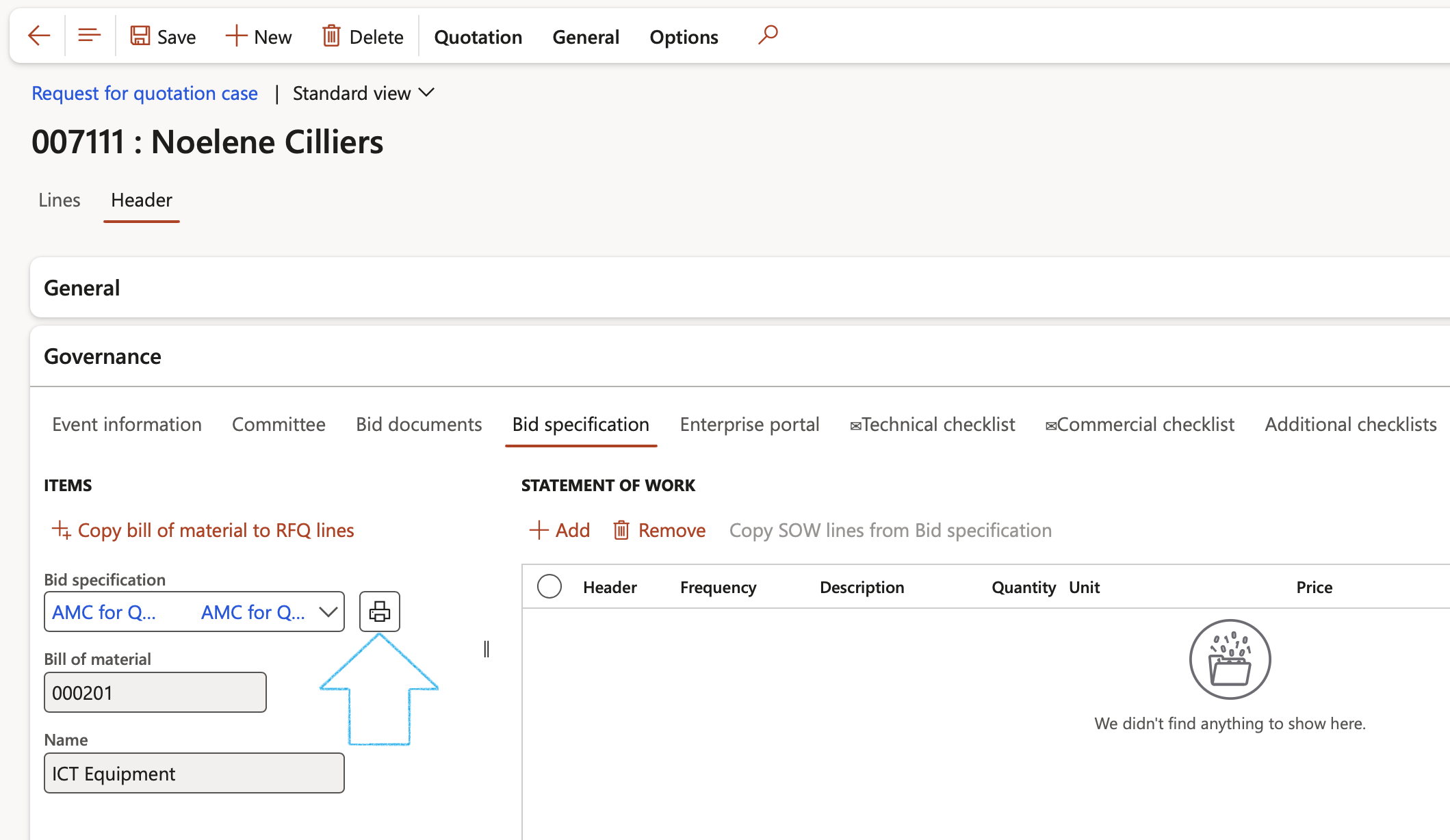

The specification can also be printed and exported to PDF or as a Word document.
A follow up might be required on the specification
Every time the Copy bill of material to RFQ lines button is clicked, the BOM lines will be copied to the RFQ again
An invitation to bid is a call by organisations to suppliers/vendors/contractors to provide specific products or services that meet product specifications. It is assumed that at this point all the building blocks are in place. These being Approval to solicit, teams available for evaluation, declarations done, proper specifications and a complete set of documents to be submitted.
There are two ways to copy the attachments from the Document pack to the RFQ:
From the default document pack:
The Attachment icon will indicate the number of attachments that are now copied to the RFQ
From a preferred document pack:
A pop-up will appear asking the user whether the attachments from the selected document pack should be copied to the RFQ

Also see the Terms and conditions Fast tab
Users can list the URL links where the advertisements are made public by using the Enterprise portal Index tab.

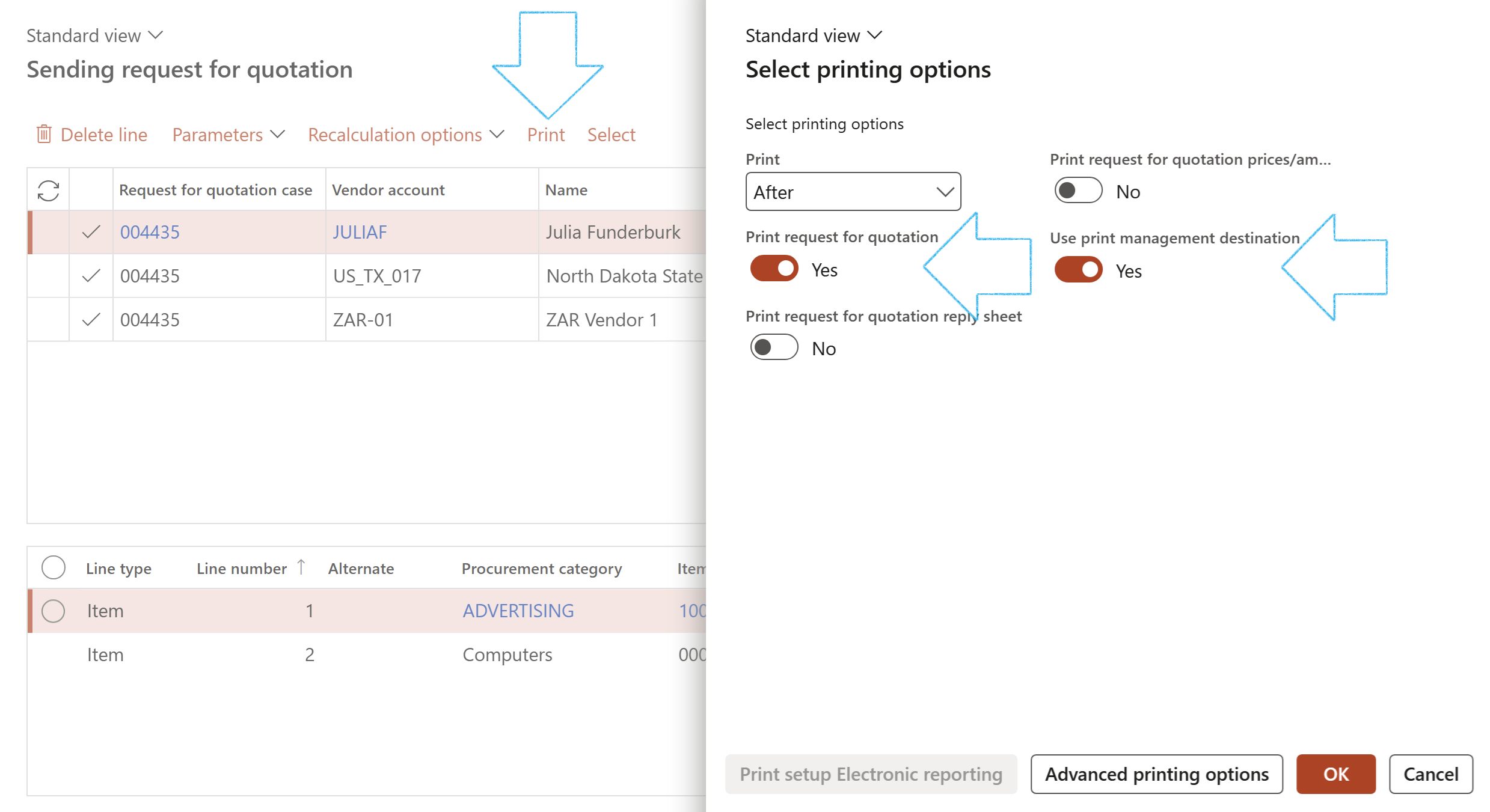

In the Button strip, click on the Add button
In the Button strip, click on the Publish button
A tender briefing session is conducted as part of the overall tender process to help the organisations team explain and present to the tenderers the general expectations and scope for the particular works to ensure they and the tender conditions are understood, allowing better and more accurate proposals.
Go to: GRC > Meetings > Meetings

The selected vendor must have a Primary email address
It is important to record the number of suppliers that attended the meeting
On selecting of a tender briefing (Governance Fast tab), GRC 365 will prompt the buyer if the would like to add the vendors from the tender briefing to the RFQ list.
If you want to create Qualification checklists for all the vendors simultaneously, click on the Select all button and then follow the steps above from the **
The feedback history/audit trail can be viewed by clicking on the View history button on the Checklist feedback form

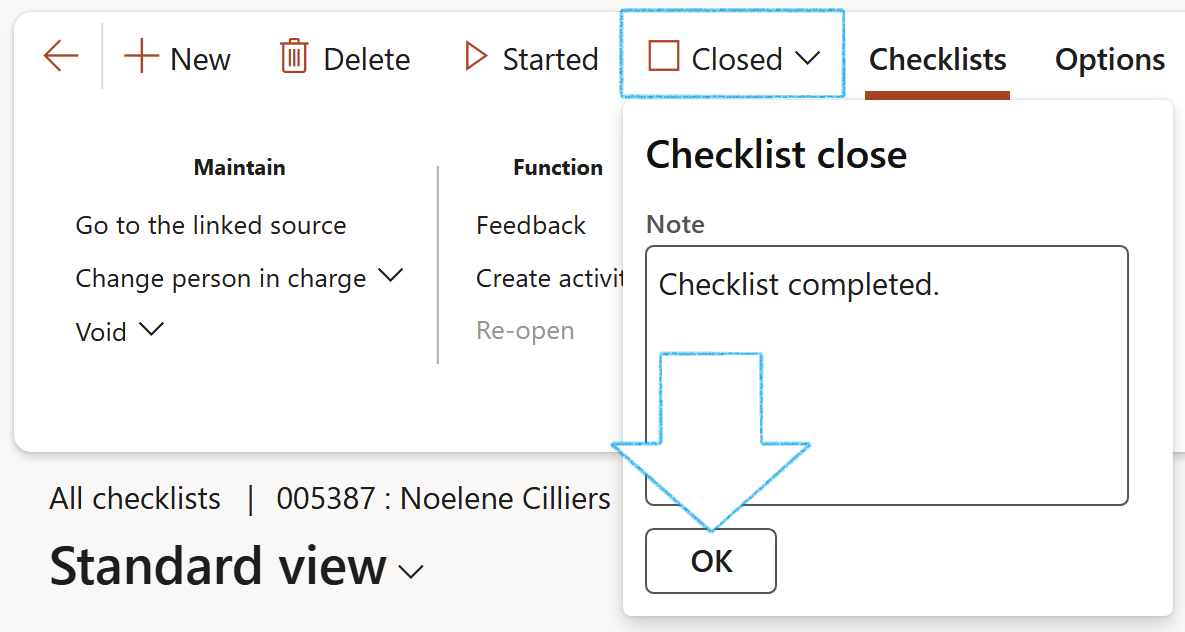

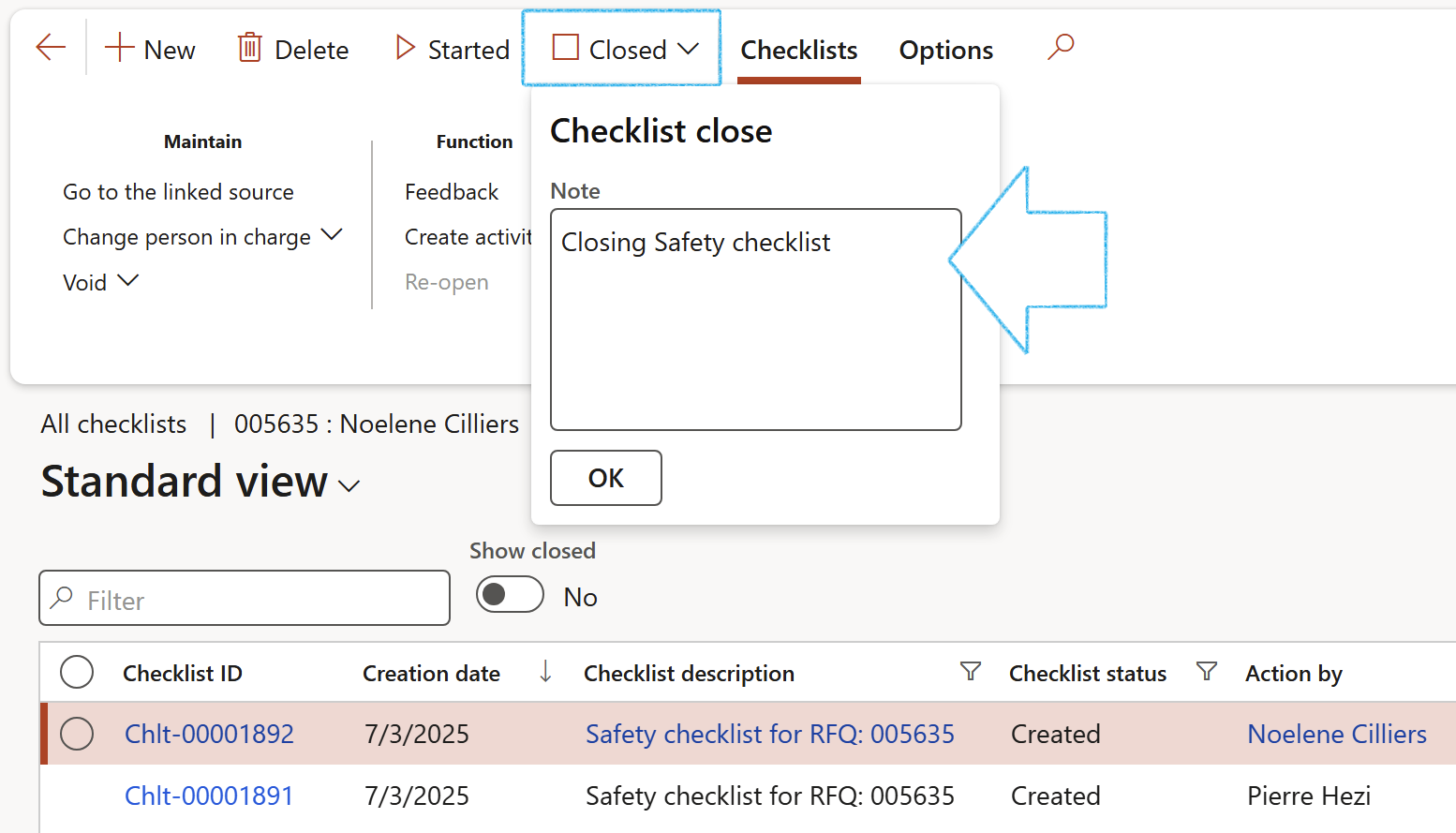

To declare that a checklist is void:
The checklist status will be changed to Void
The Task status of the checklist lines will be changed to Cancelled
Scroll to the right to see the Comply/Disqualify entries
When the status of a vendor under the Vendor Fast tab is Accepted or Rejected, the following buttons in the button strip will be disabled for that vendor:
- Comply
- Disqualify
- The Create qualification checklist option under the Vendor options button
A message will appear in the Action center confirming that the RFQ has been sent to the selected vendors
The status of the RFQ will now be In progress
Bid analysis involves examining bids after the tender submission deadline. It helps identify the most suitable offer that meets the requesting organisation’s needs.
The process normaly includes a qualification step. The organisation’s team will evaluate each bid during this preliminary stage. They will check if the bid is signed, has the necessary security, and contains no omissions or errors. Additionally, they will assess if the documents meet all legal and tax requirements. Bids that do not meet these conditions will not advance to the next step.
Normally a formal bid envelope opening step is involved.
The second step is to assess whether the bid meets the technical requirements for the project. This includes the material quality, delivery timeline, scope of works, warranties, and the bidder’s experience. The technical specifications vary depending on the project.
The final step is what is known as a commercial evaluation. Here the main evaluation points considered are costs and their influencing factors, such as unit pricing, labor rates, labor hours, overheads and profits, price lock (the duration price is guaranteed), material costs, quantities, and quality.
Assuming some bidders were disqualified via the above process; buyers can now move to the evaluation of responses based on a technical and commercial type of analysis.
Please note: If the Technical job plan or Commercial job plan is changed on the Solicitation type after checklists have been created on the RFQ, the checklists will disappear from the RFQ
A formal checklist (steps to guide the buyers when qualifying bid suppliers) can be created to aid in the procurement process
Go to: GRC > Governance > Tender management > All requests for quotations
- Note that Technical and Commercial checklists will not be created if the highest status of at least one vendor/supplier is sent/received
- The Job plan can only be changed by members in the Scoring team/committee
A pop-up will appear to confirm that a Technical team exists and that a checklist will be created for each team member, or only for the team leader
A blue confirmation message will appear. The number on the right hand side is an indication of the number of checklists that were created.
It is important to note that the Role selected for the committee has to be one of the following:
- Commercial – for the Commercial checklists
- Technical – for the Technical checklists
Example: If there are 3 Suppliers and 2 Technical committee members, 6 Technical checklists will be created
A formal checklist (steps to guide the buyers when qualifying bid suppliers) can be created to aid in the procurement process
Go to: GRC > Governance > Tender management > All requests for quotations
- Note that Technical and Commercial checklists will not be created if the highest status of at least one vendor/supplier is sent/received
- The Job plan can only be changed by members in the Scoring team/committee
A pop-up will appear to confirm that a Commercial team exists and that a checklist will be created for each team member, or only for the team leader.
A blue confirmation message will appear. The number on the right hand side is an indication of the number of checklists that were created.
It is important to note that the Role selected for the committee has to be one of the following:
- Commercial – for the Commercial checklists
- Technical – for the Technical checklists
Example: If there are 2 Suppliers and 6 Commercial committee members, 12 Commercial checklists will be created

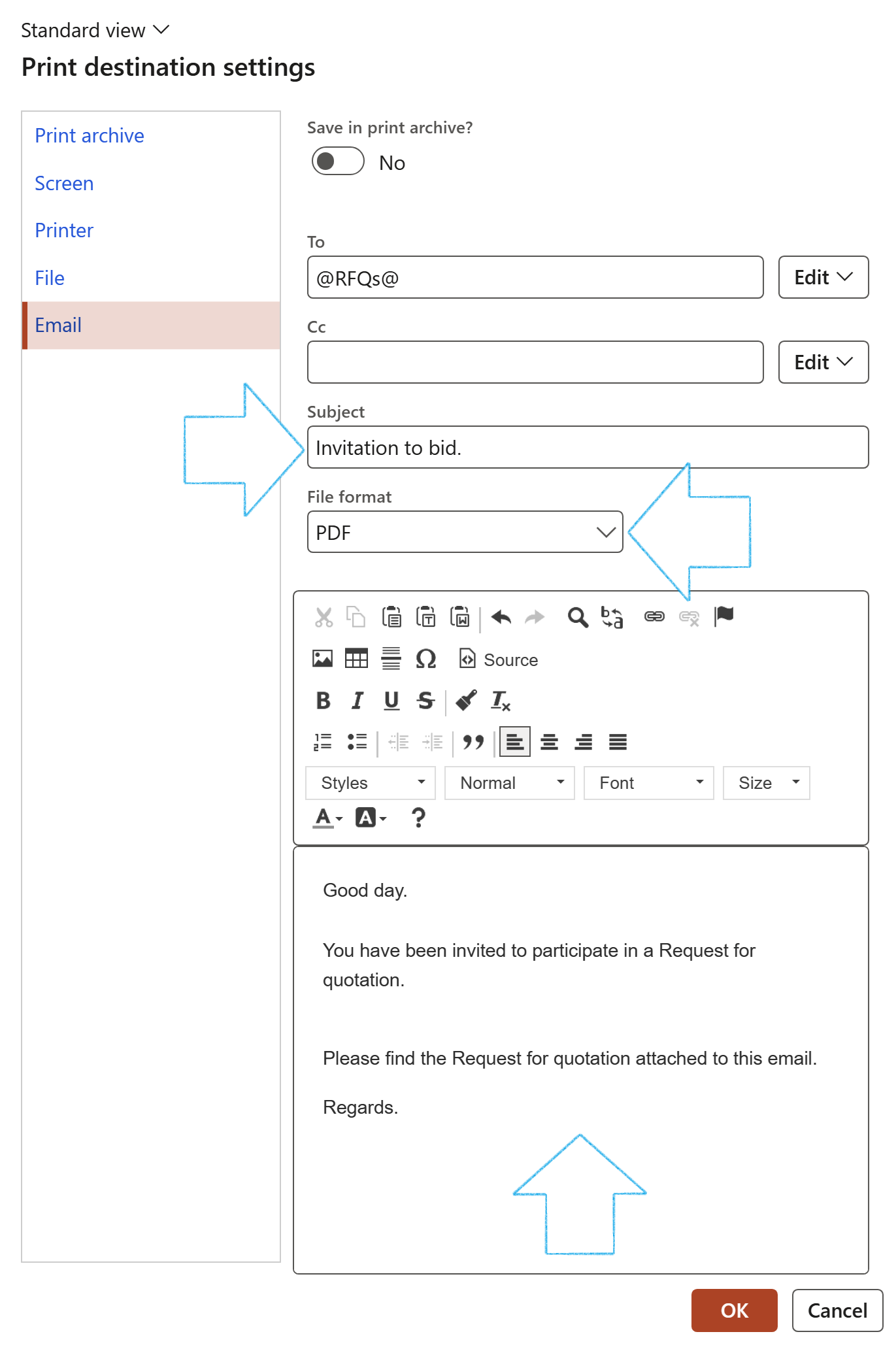

Email template placeholders:
Placeholder mappings | Field on form |
---|---|
%RFQCaseNumber% %RFQDocumentTitle% %RFQExpiryDate% %ChecklistId% %RequestedBy% %ChecklistStatus% %ChecklistDueDate% %urlLink% |
RFQ Number RFQ Title RFQ Expiry date Checklist ID Requested by Checklist status Checklist due date Hyperlink – Checklist |
The opening of bid envelopes is part of the bid evaluation process. Technical and Commercial teams are selected on the Solicitation type. It is also determined who can open the envelopes. The default is that only team leaders can open their envelopes.
On the Procurement plan header, under the Planning and approvals Fast tab, users can determine how and when envelopes will be opened by selecting the relevant value in the Bid opening field.
The Open envelopes button on the RFQ will only be available if the logged in user is a member in the committee/team selected on the Solicitation type, and on the date specified on the Procurement plan. Only members of the technical and commercial teams can open their respective envelopes for an RFQ, as long as the envelope's opening date is not earlier than the current date.
Go to: GRC > Governance > Tender management > All requests for quotations
A record with these details will be added on the RFQ header under the Sign off Fast tab
It is assumed that the Purchaser has already updated the commercial values on the RFQ manage replies form, or alternatively, the Vendor used the Self-service portal functionality.
If users want to have a step-by-step to-do-list of tasks to be performed in the evaluation, a formal to-do-list with tasks can be created. A default list of tasks is created using the HRM checklist and linked to the Solicitation type.
To create tasks from the Manage replies from:
Only tasks assigned to the logged in user will be displayed on the Task maintenance form
The user can do the following by clicking on the buttons in the Action pane:
- View details of the task
- Chanage status of the task
- Reassign the task
The tasks will also be on the Home page under the logged in user's To-do-list
The following points have to be done so that evaluation can be done on Technical checklists
To view the Technical documents supplied by the vendor, click on the View envelope button in the Action pane

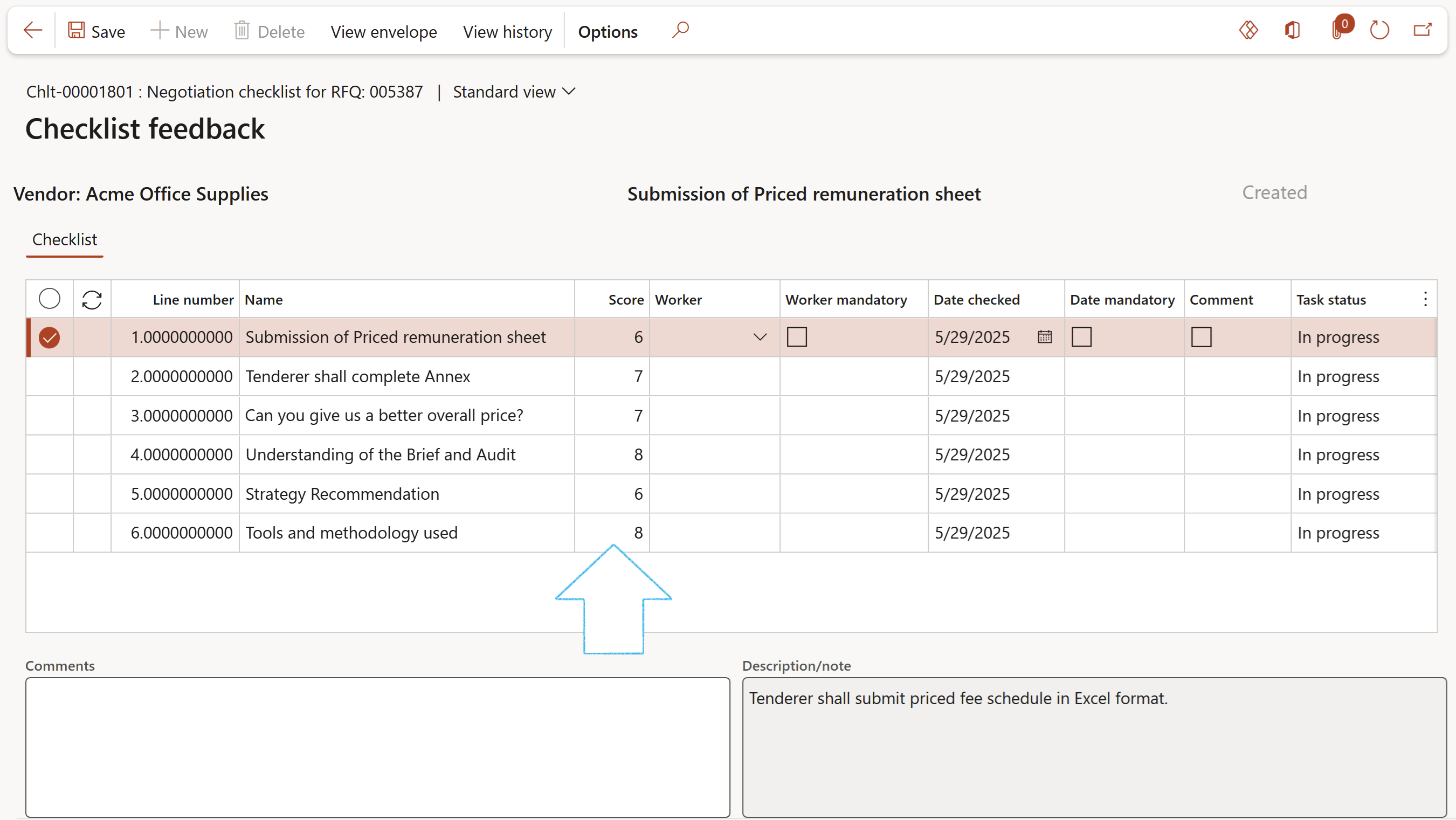

To view the scoring history for the selected line, click on the View history button in the Action pane
To declare that a checklist is void:
The checklist status will be changed to Void
The Task status of the checklist lines will be changed to Cancelled
- On the Job plan, under the General Fast tab, in the Checklist option field, the selected value has to be Default, and the Pass threshold for the job plan entered.
- A Technical job plan and a Technical evaluation team must be selected on the Solicitation type that was selected when the RFQ was created.
Soon to be added:
Once all the checklists have been scored, click on the Auto disqualify button. All vendors that have a score lower than the Pass threshold specified on the job plan, will be disqualified.
The following points have to be done so that evaluation can be done on Commercial checklists

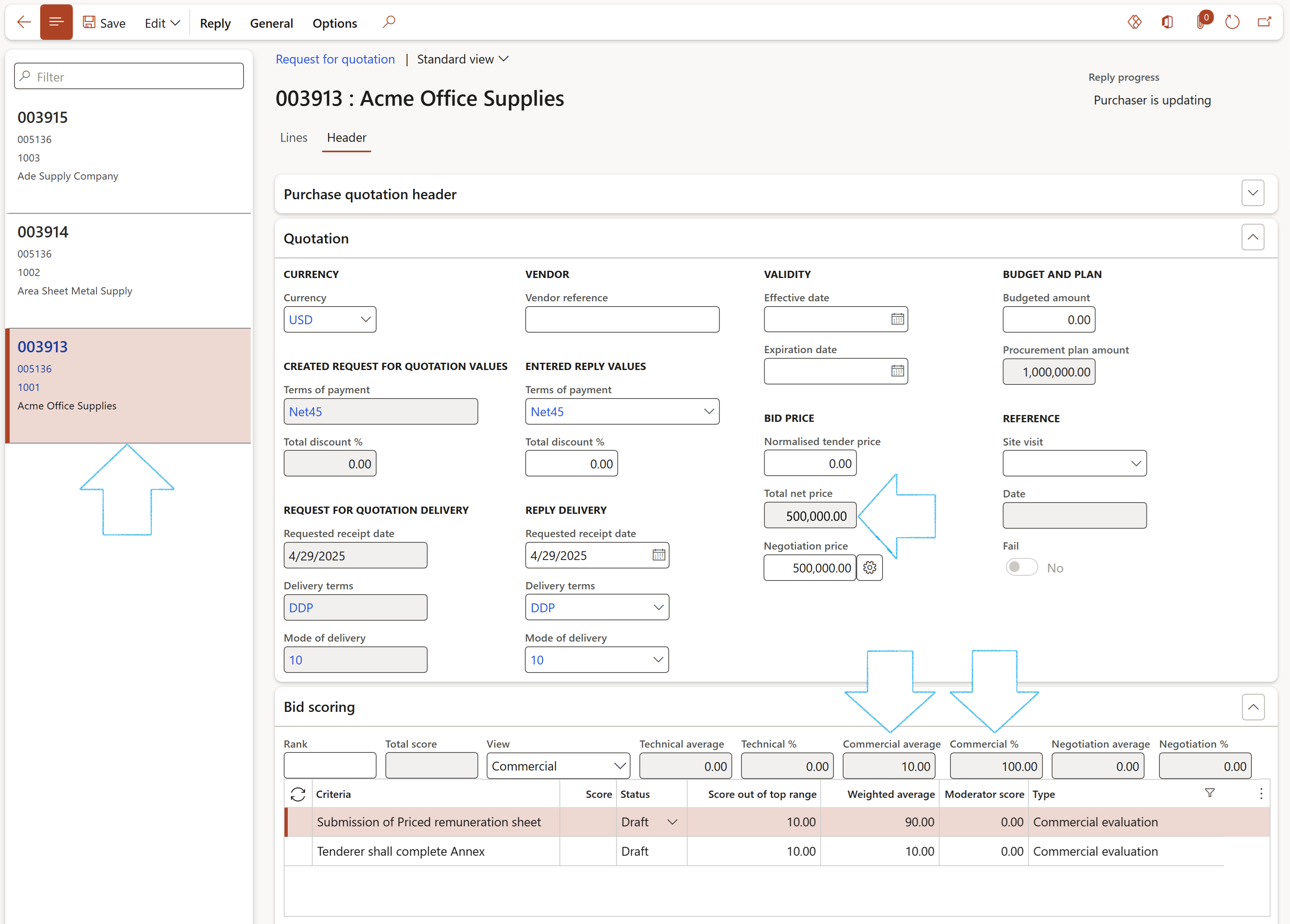

To view the Commercial documents supplied by the vendor, click on the View envelope button in the Action pane
To view the scoring history for the selected line, click on the View history button in the Action pane
- On the Job plan, under the General Fast tab, in the Checklist option field, the selected value has to be Default, and the Pass threshold for the job plan entered.
- A Commercial job plan and a Commercial evaluation team must be selected on the Solicitation type that was selected when the RFQ was created
Soon to be added

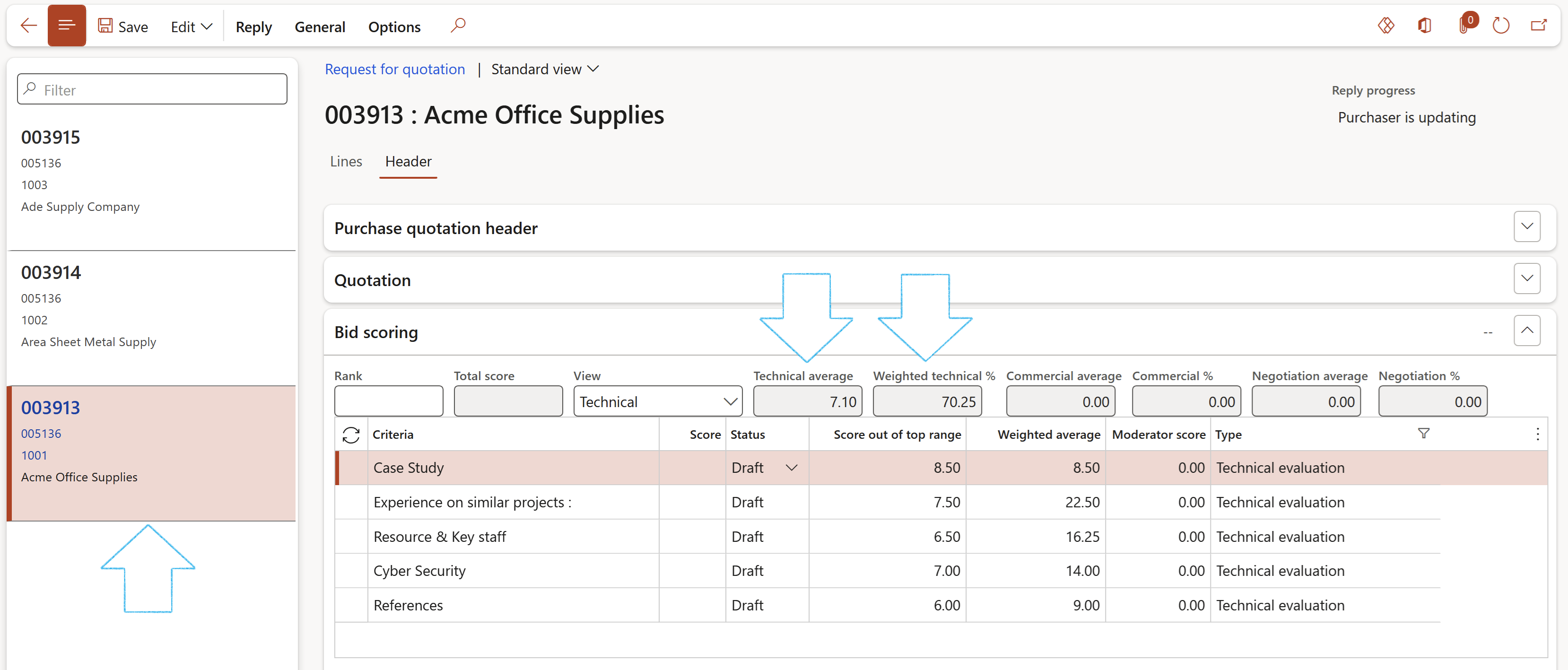

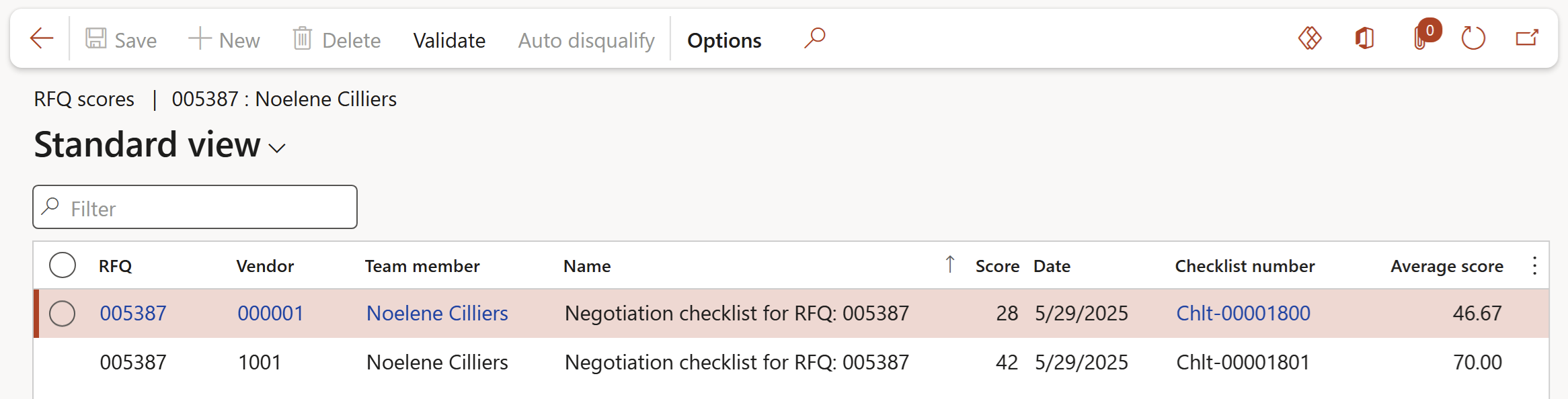

To view Technical scores:
To view Commercial scores:
Disqualify bidder after reference checks:
On the RFQ header, under the Vendor Fast tab, it will be indicated that the vendor is now Disqualified
- The Scoring criteria form will be locked, and the status of all the lines will be Frozen
- All checklist headers will have a status of Void
- All checklist lines will be Cancelled
- A record will be added under the Sign off Fast tab
- On the Manage replies header, all the records under the Bid scoring Fast tab, will be locked and the status for all the lines will be Frozen

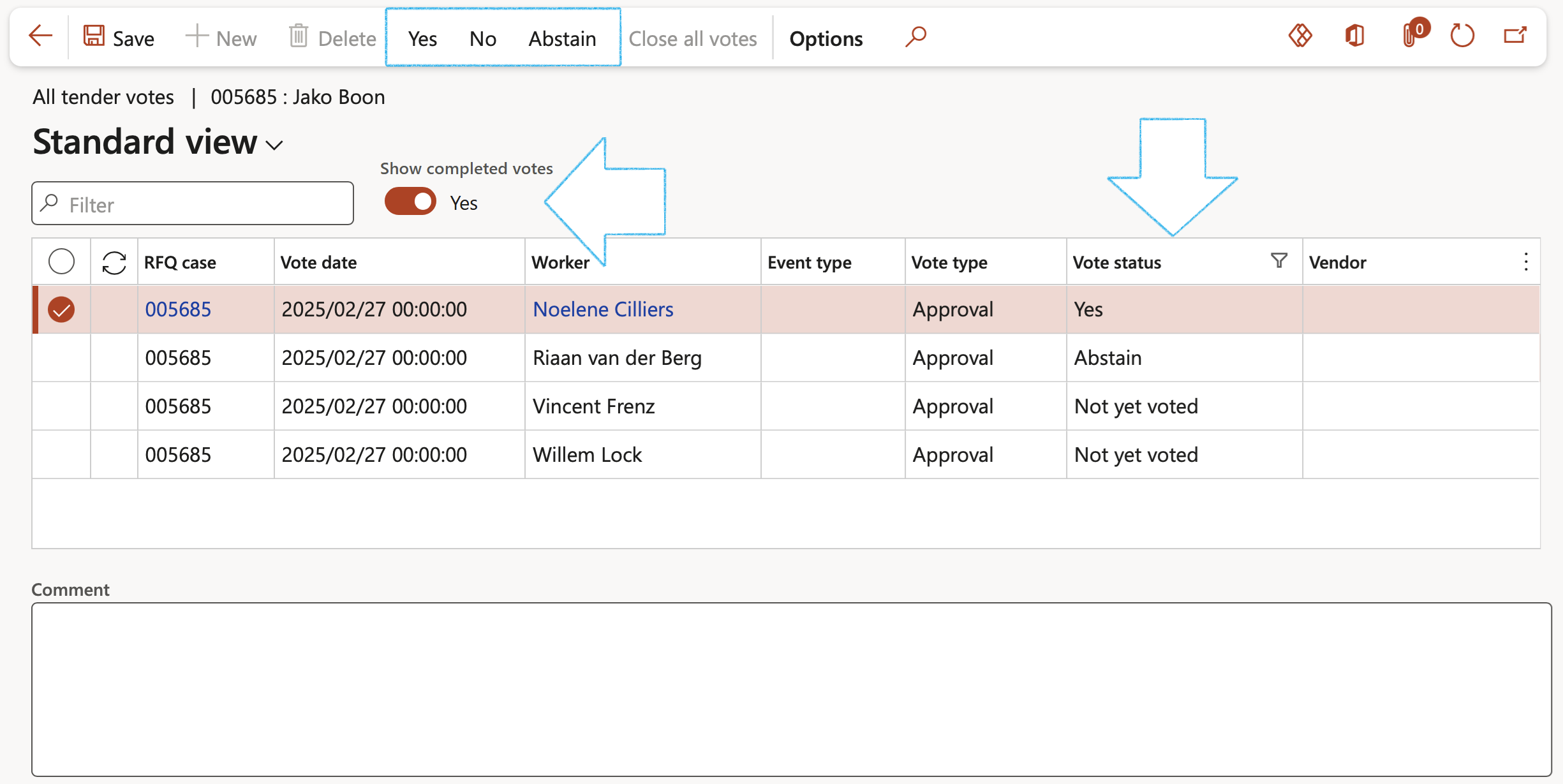

Moderators can enter their scores on the RFQ replies form
- Only users that belong to the Moderator committee can enter values in the Moderator score column
- No changes can be made to the scores if the status of the lines is Frozen

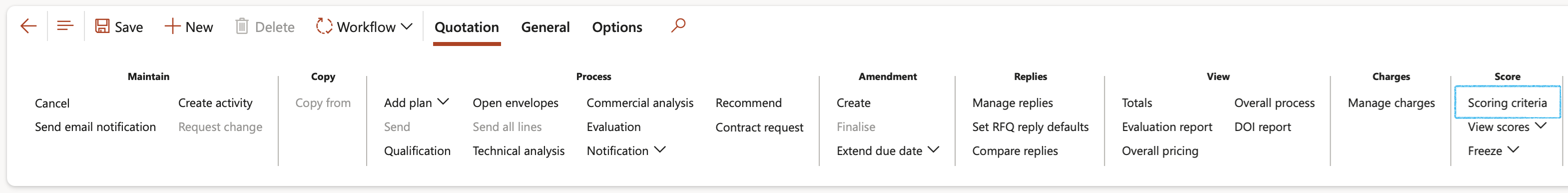

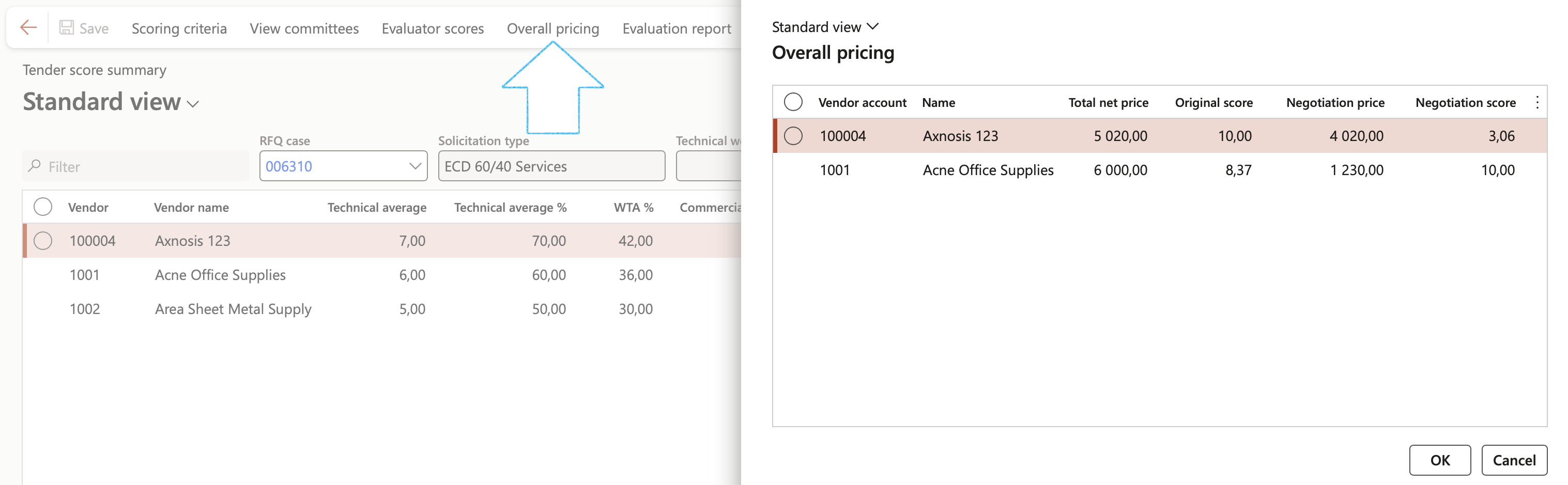

Evaluation will give users a summary view of all suppliers, their responses and their certification level. The system will apply the 80/20 or 90/10 rules from the procurement plan.
Go to: GRC > Governance > Tender management > All requests for quotations
If all the Vendors’ replies have been received and all the bids are greater than the maximum value of bid as specified on the Solicitation type, a message will pop up, giving the user the option to cancel the RFQ.
If Yes is selected, the Cancel RFQ wizard will open to guide the user through all the required steps:
The following confirmation messages will be displayed on the RFQ:

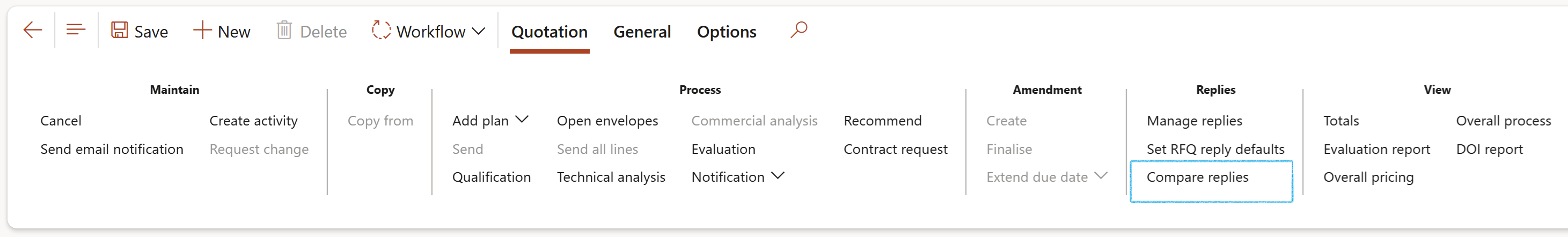

Replies from suppliers can be compared as follows:
A warning will come up if a baseline contract does not exist on the selected solicitation type.

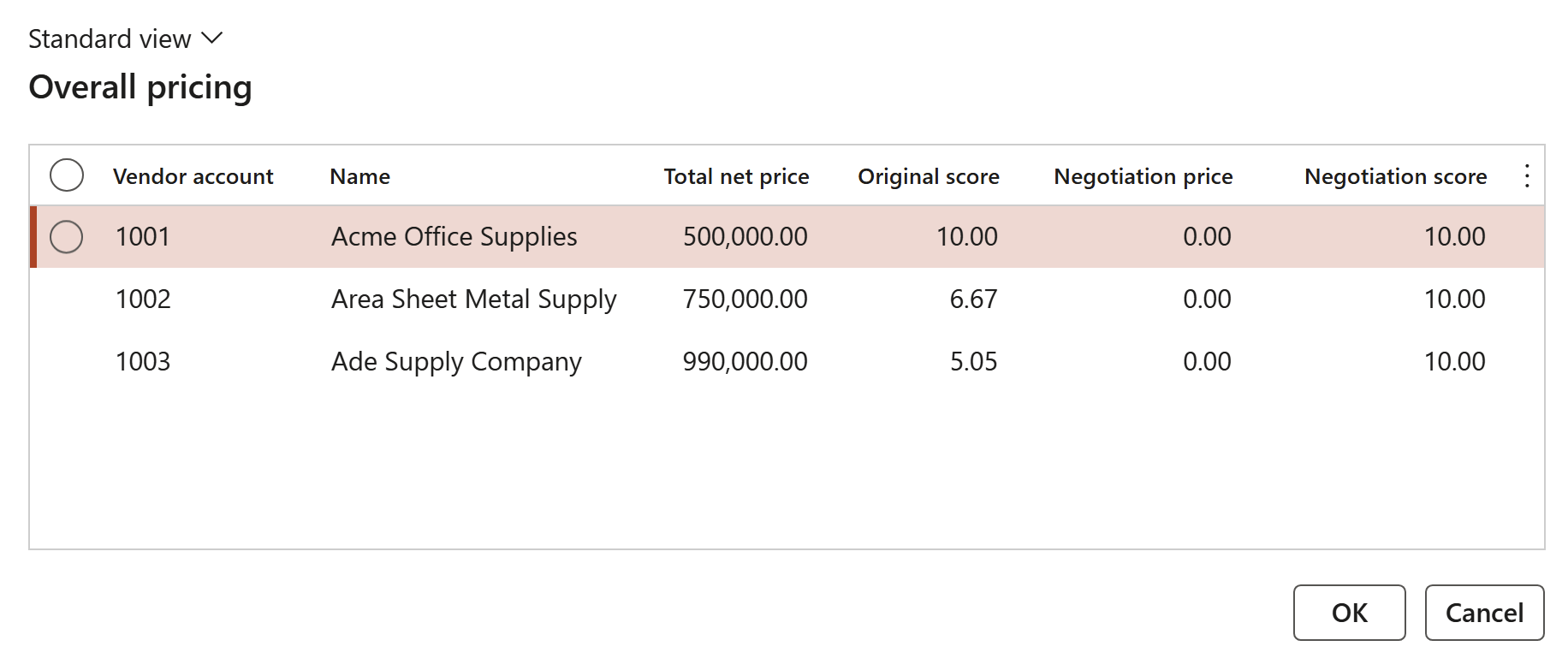

On the Compare request for quotation replies, a summary of the Header and Lines of the vendor’s quotes can be viewed

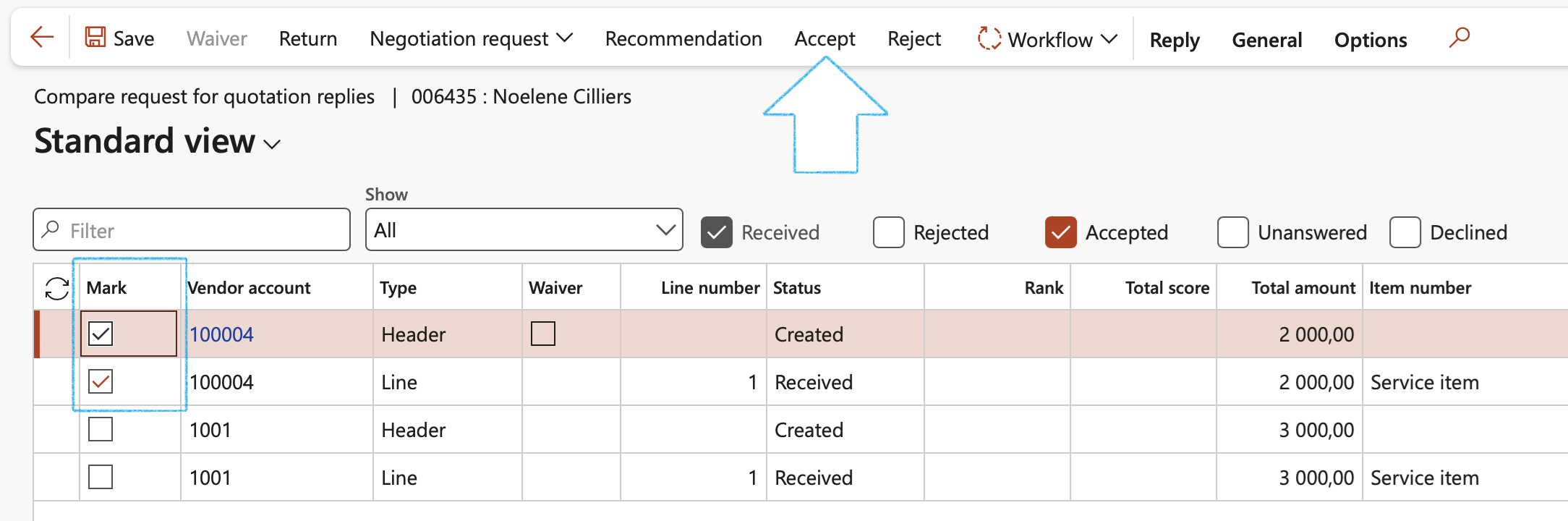

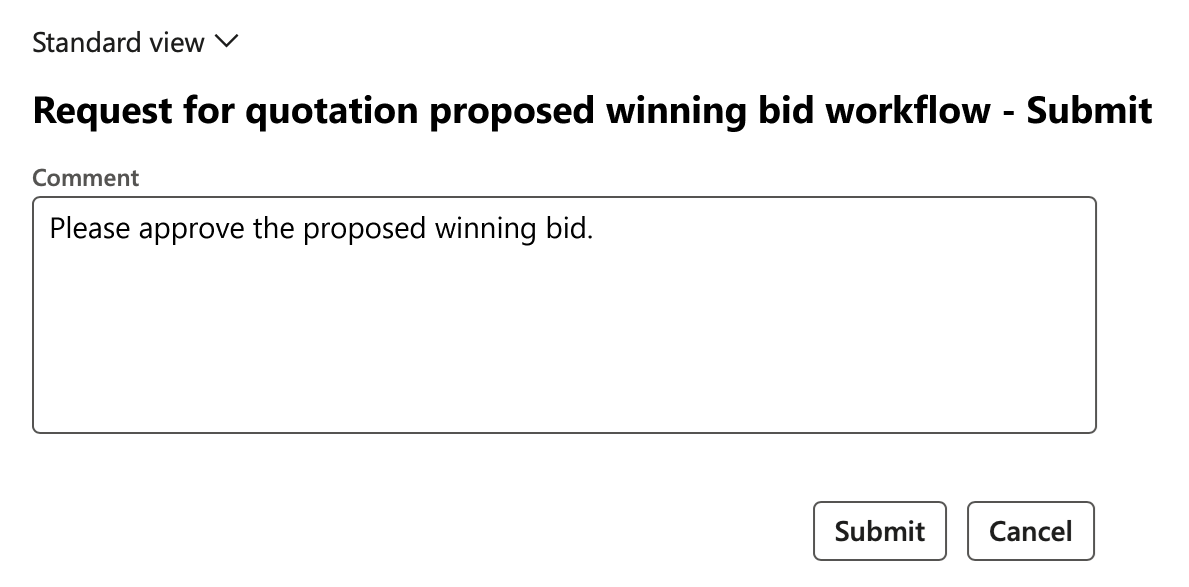

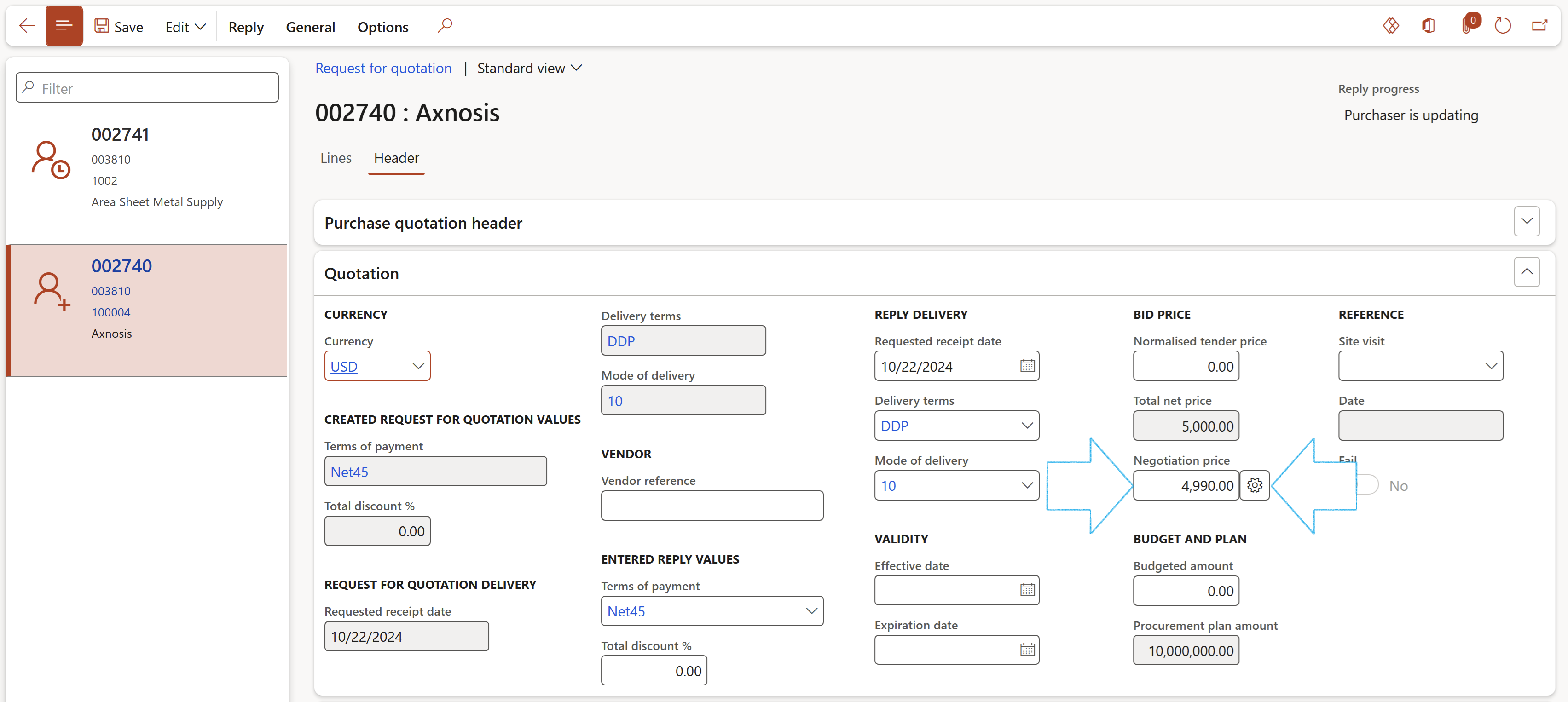

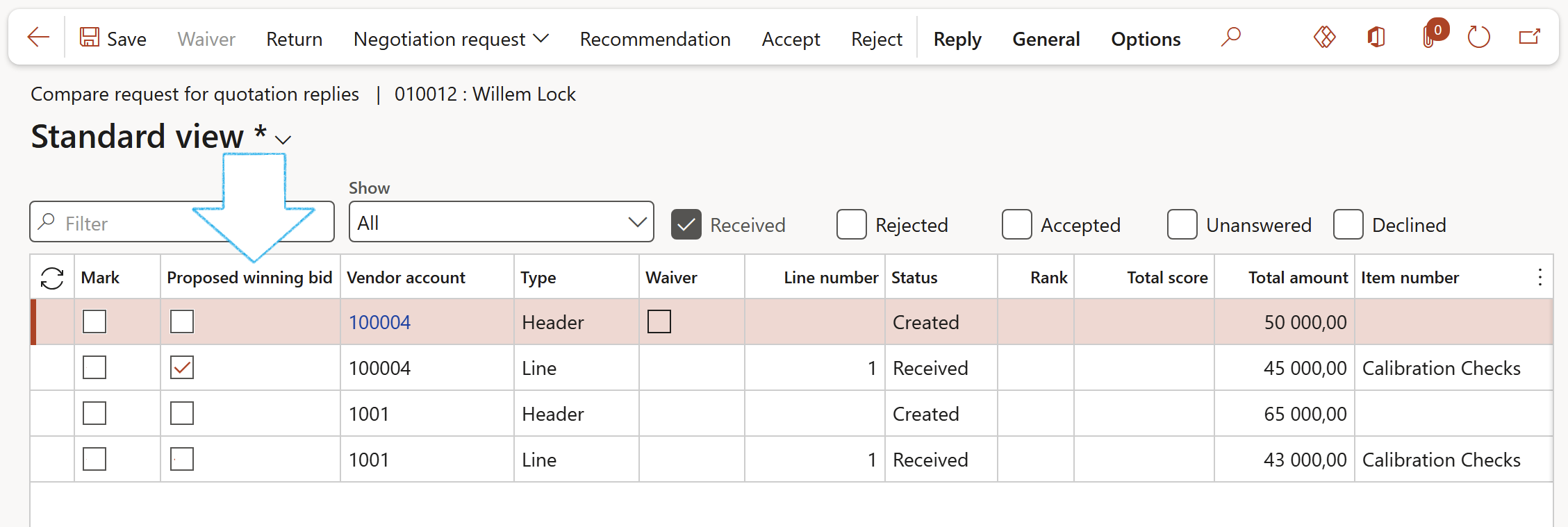

The accepting of a quote can also be done from the Manage replies form:
After accepting the RFQ, the Rejecting request for quotation form will open with the RFQ details of the vendor that was not accepted.
- Click OK to reject the RFQ
After accepting the vendor’s bid on the RFQ, the status of the Procurement plan will be updated to Awarded

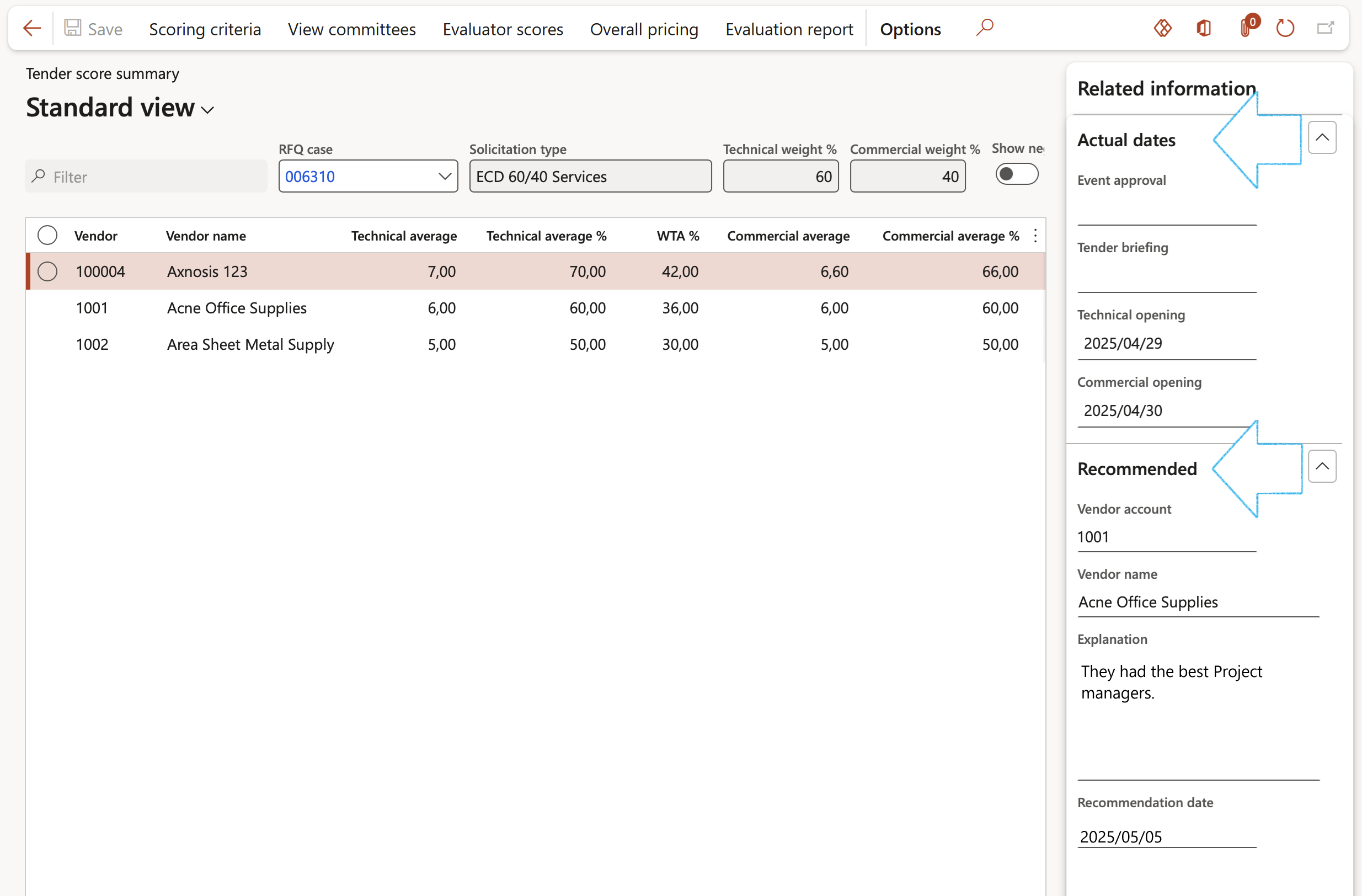

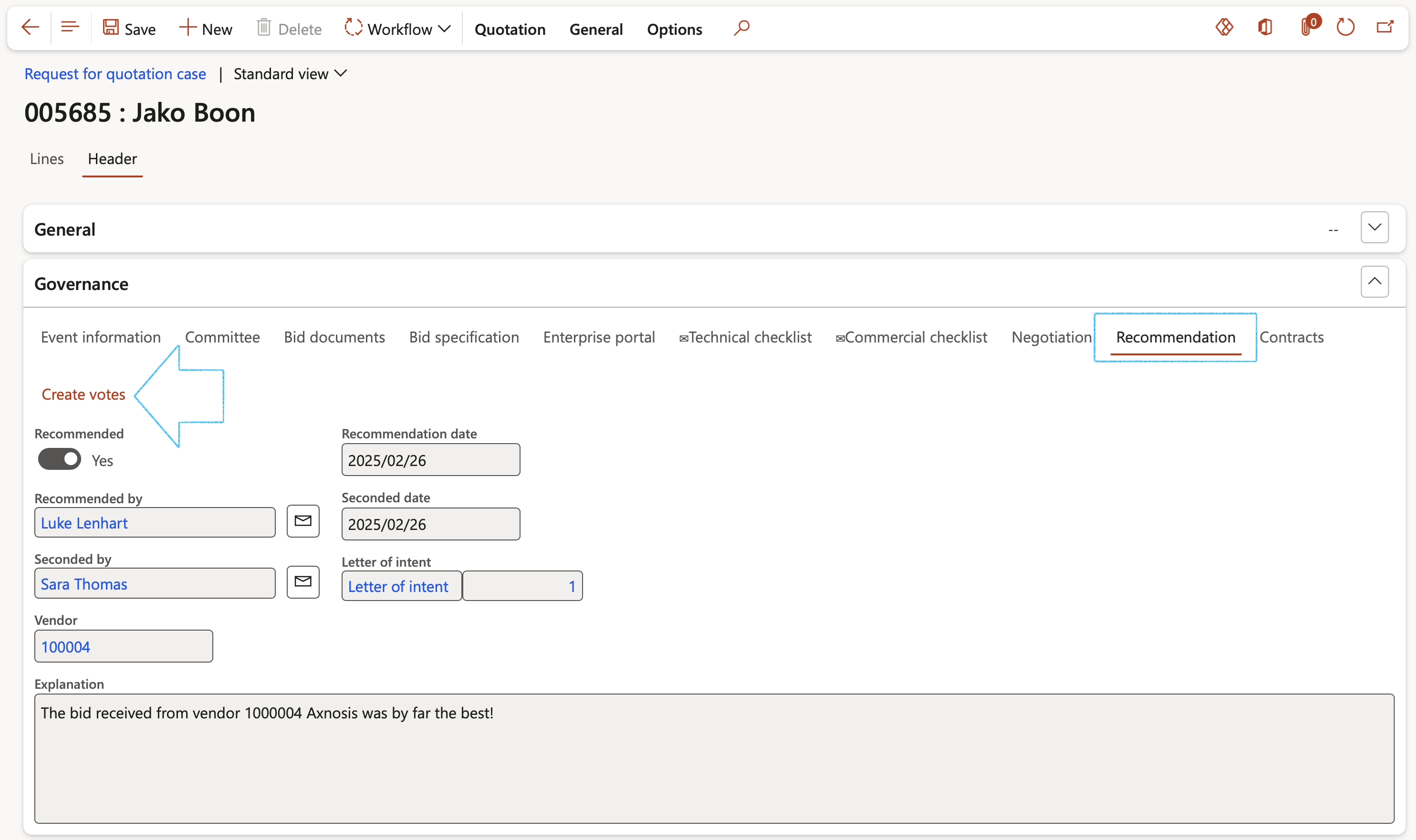

Vendors can be recommended as follows:
Go to: GRC > Governance > Tender management > All requests for quotations
The Letter of intent is created under the Other documents menu item. The document type must be Other, and the record has to be marked as a Baseline document. The Baseline record must be Approved.
The Recommend button will only be available when the status of at least one vendor = Received/Recieved
Post-Tender Negotiation is a separate exercise from Tender evaluation and clarification. It is contact between the procurement officer and the bidder(s) to refine and improve the bid(s) received in order to ensure that prices, delivery or associated terms of the contract are competitive.

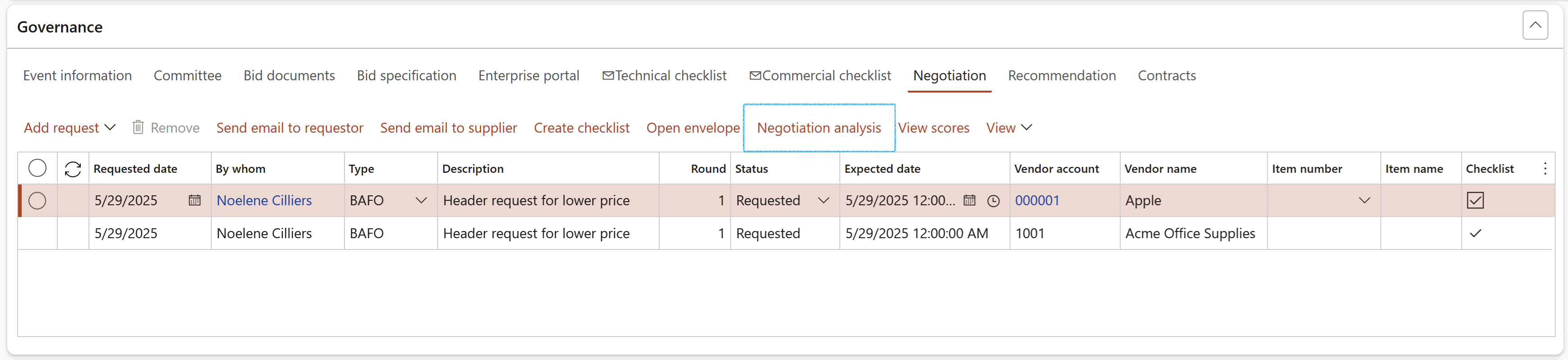

Negotiation is conducted after the receipt of formal tenders by the procurement officer, and before the award of any contract. It is not used in all procurements, and when it is used, an audit trail will be kept by the procurement officer so that it can be seen that Negotiation was conducted in a fair manner.

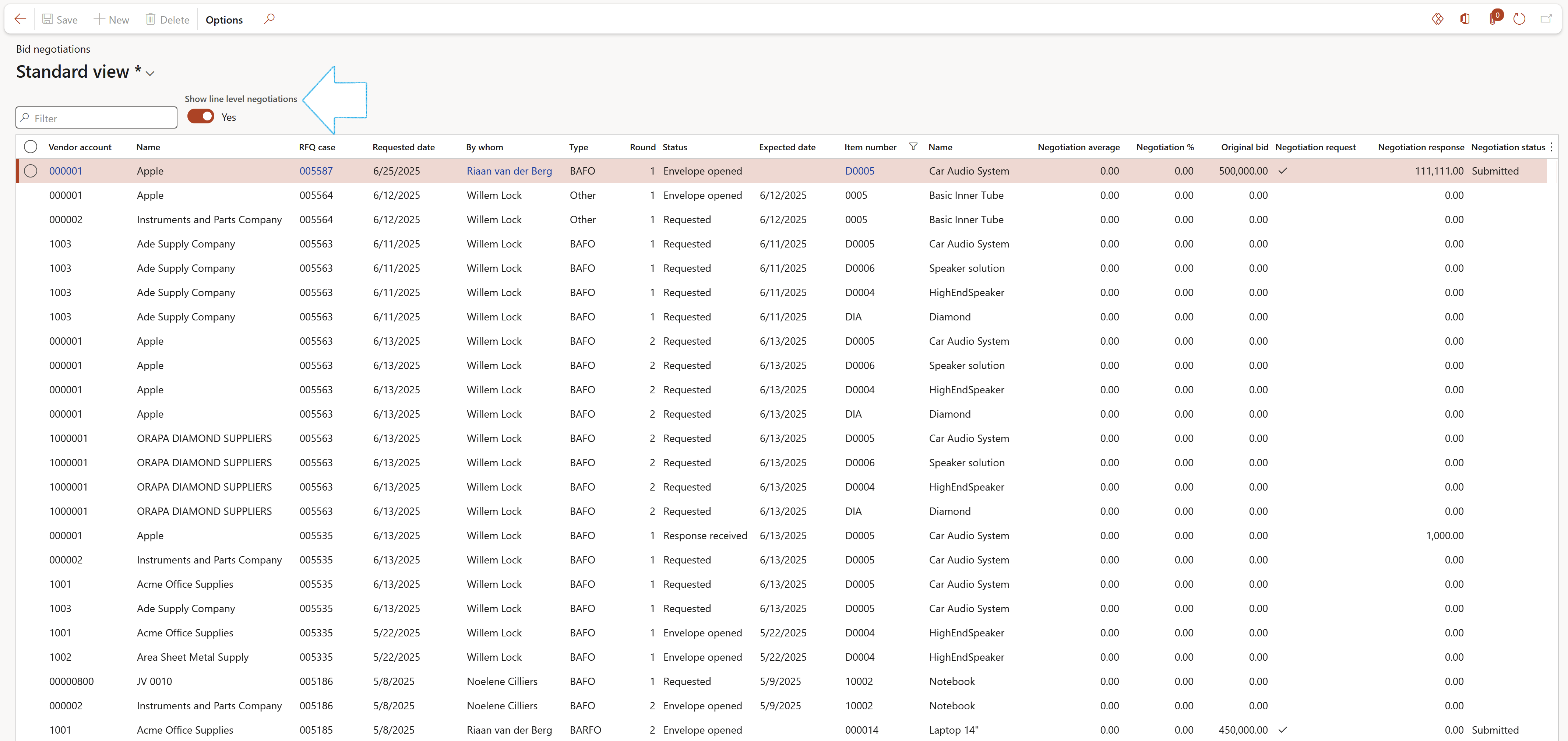

Users can keep track of negotiations with vendors

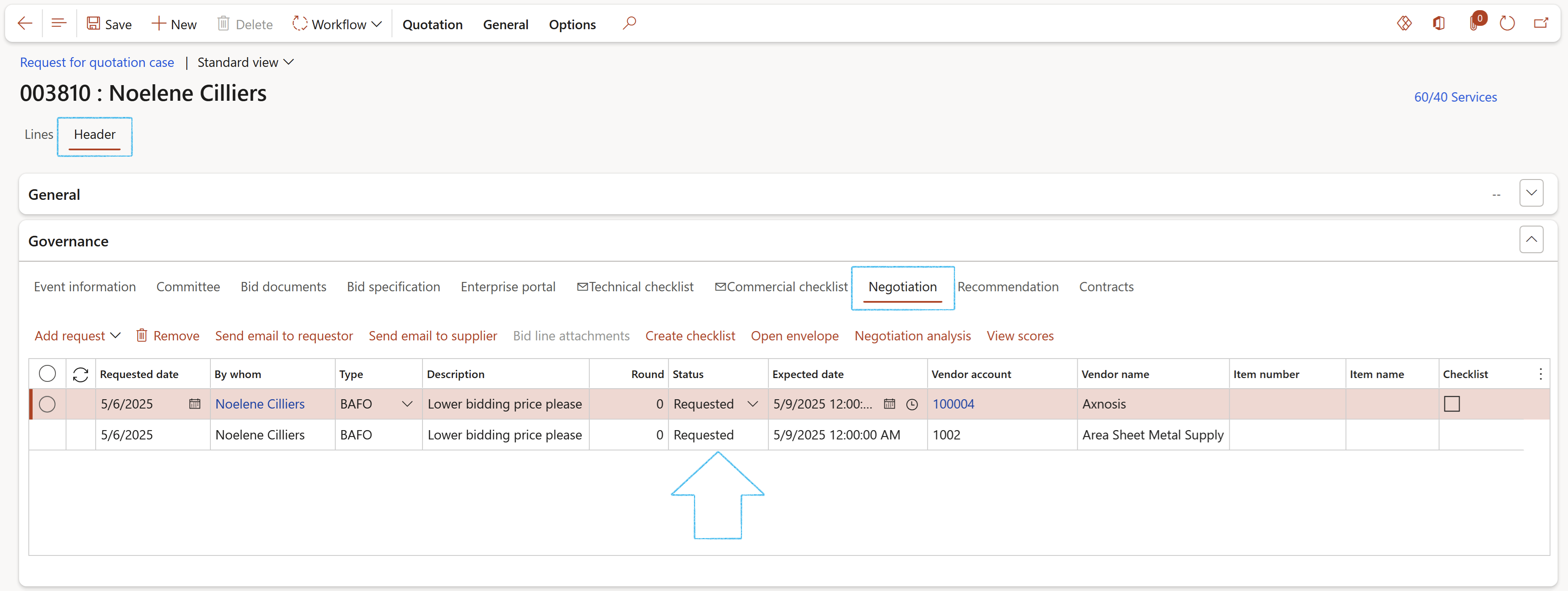

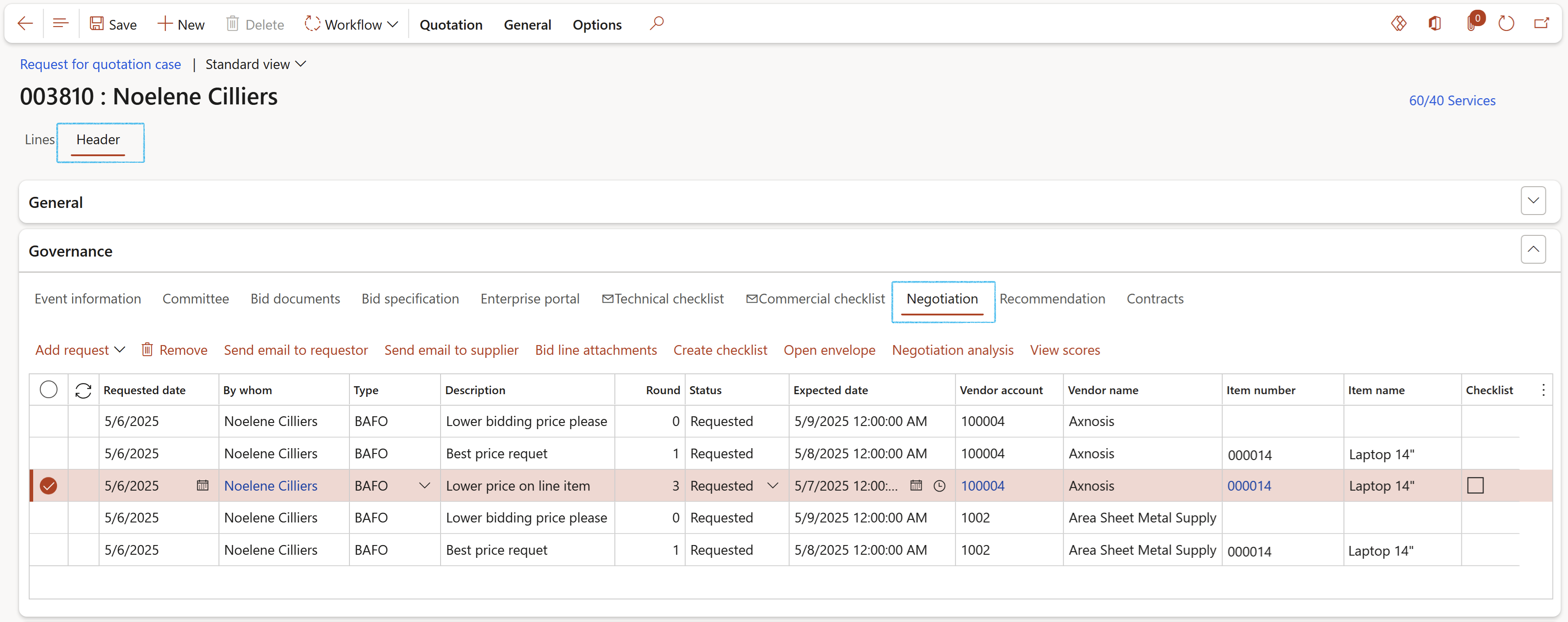

Requests for negotiations can be done on header or line level

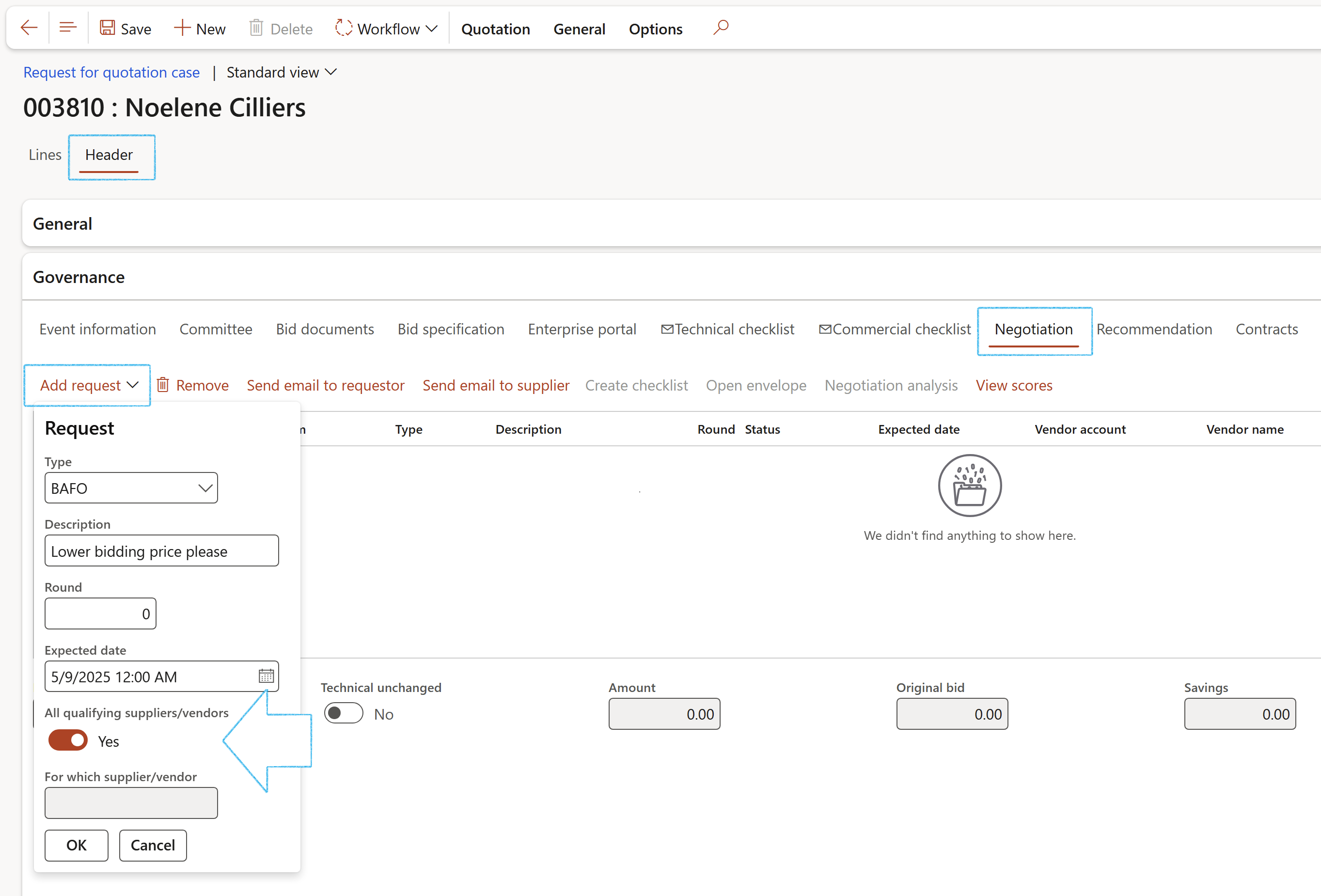

Request for negotiation on header level
Go to: GRC > Governance > Tender management > All requests for quotations
The vendor status has to be Recieved

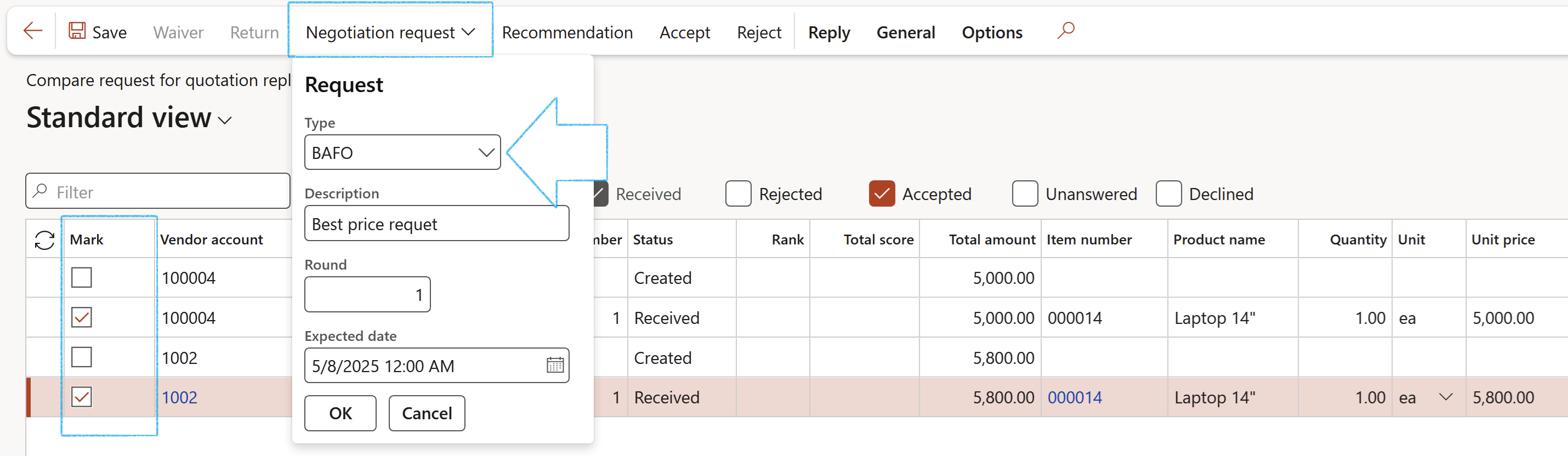

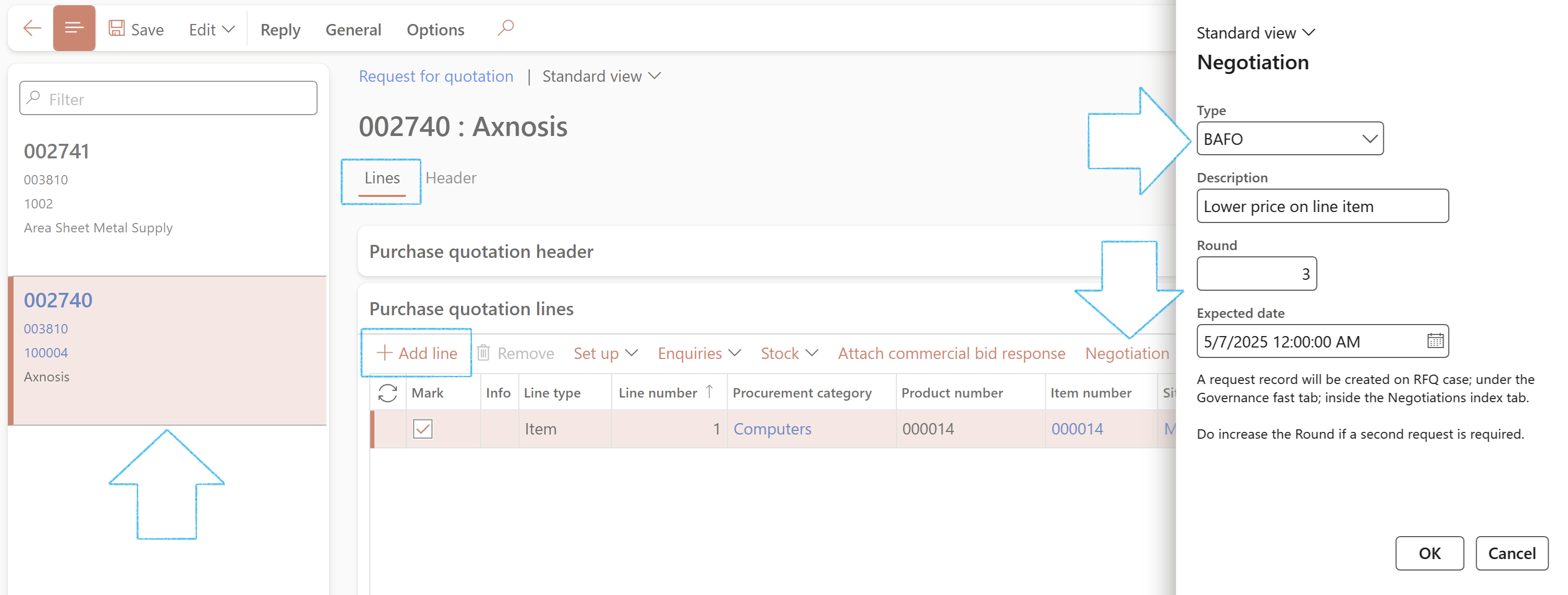

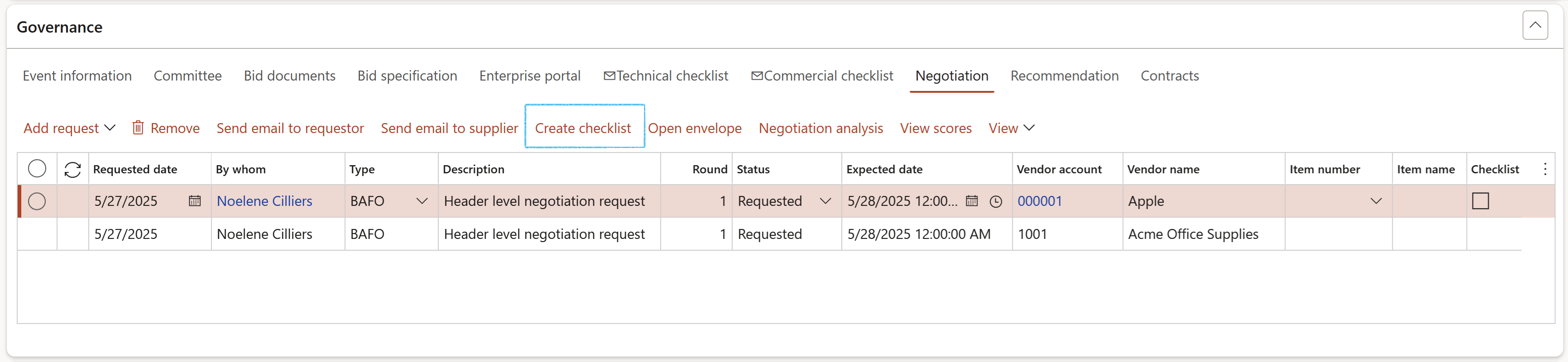

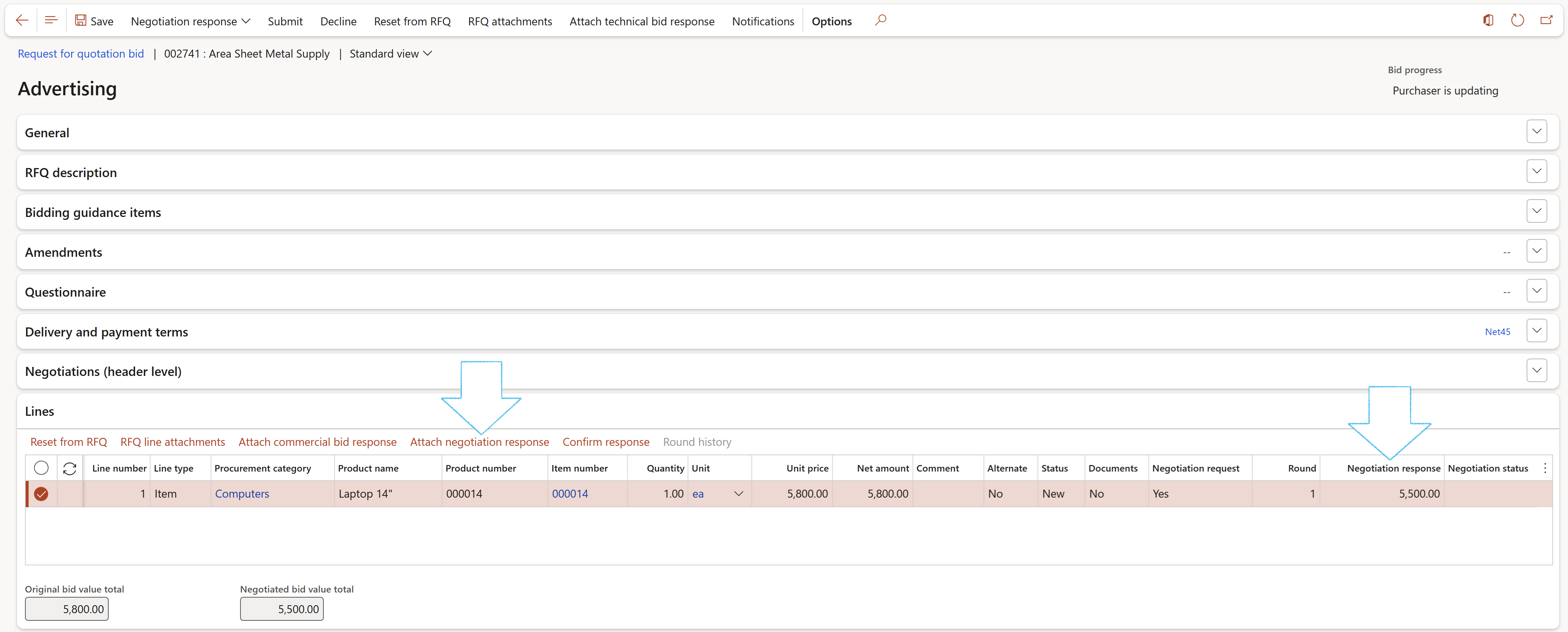

Request for negotiation on line level

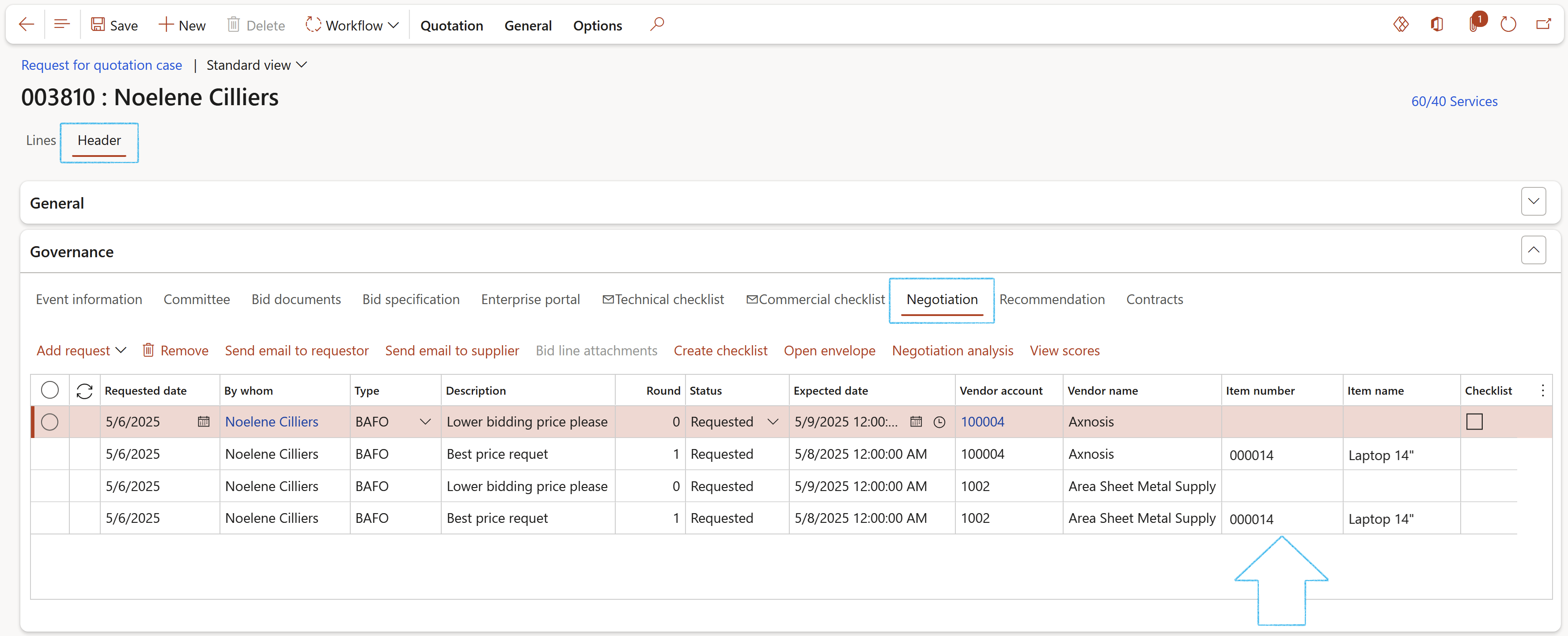

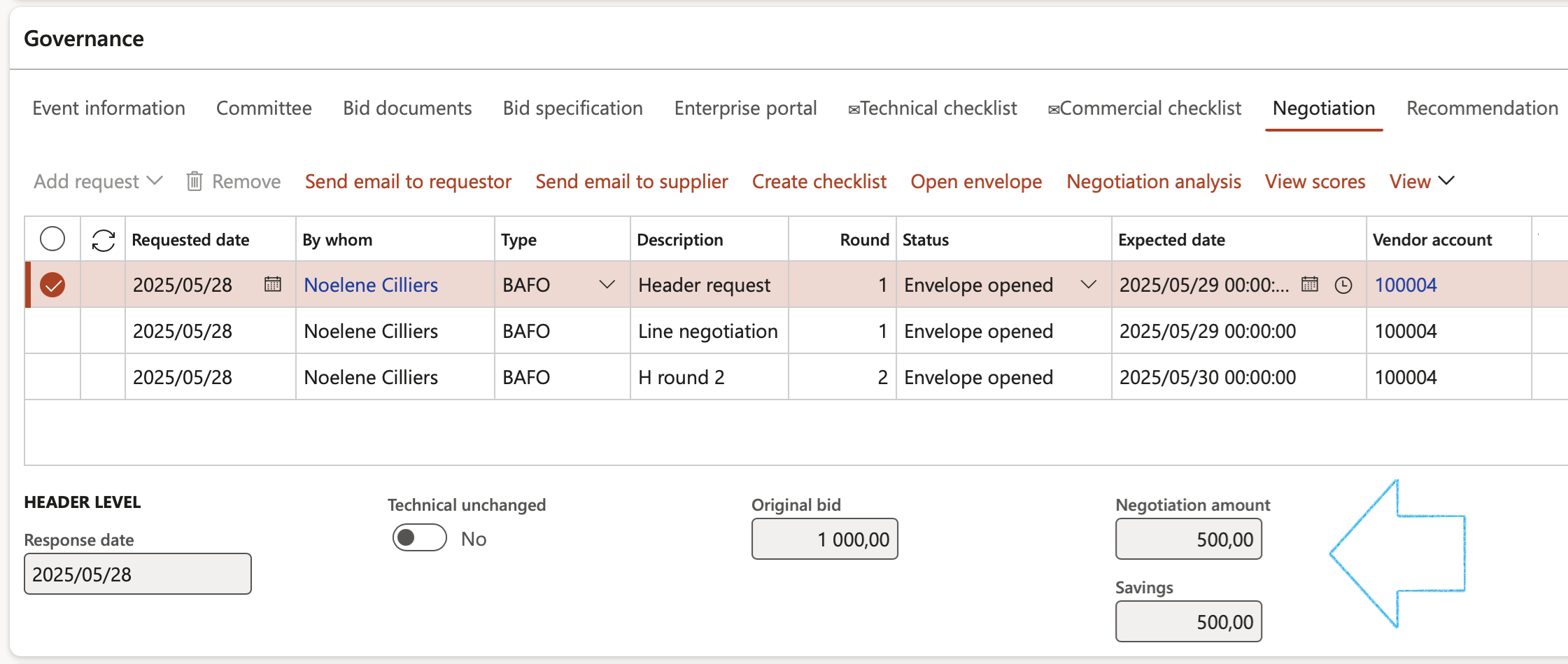

A record will be added on the RFQ header, under the Governance Fast tab, Negotiation Index tab

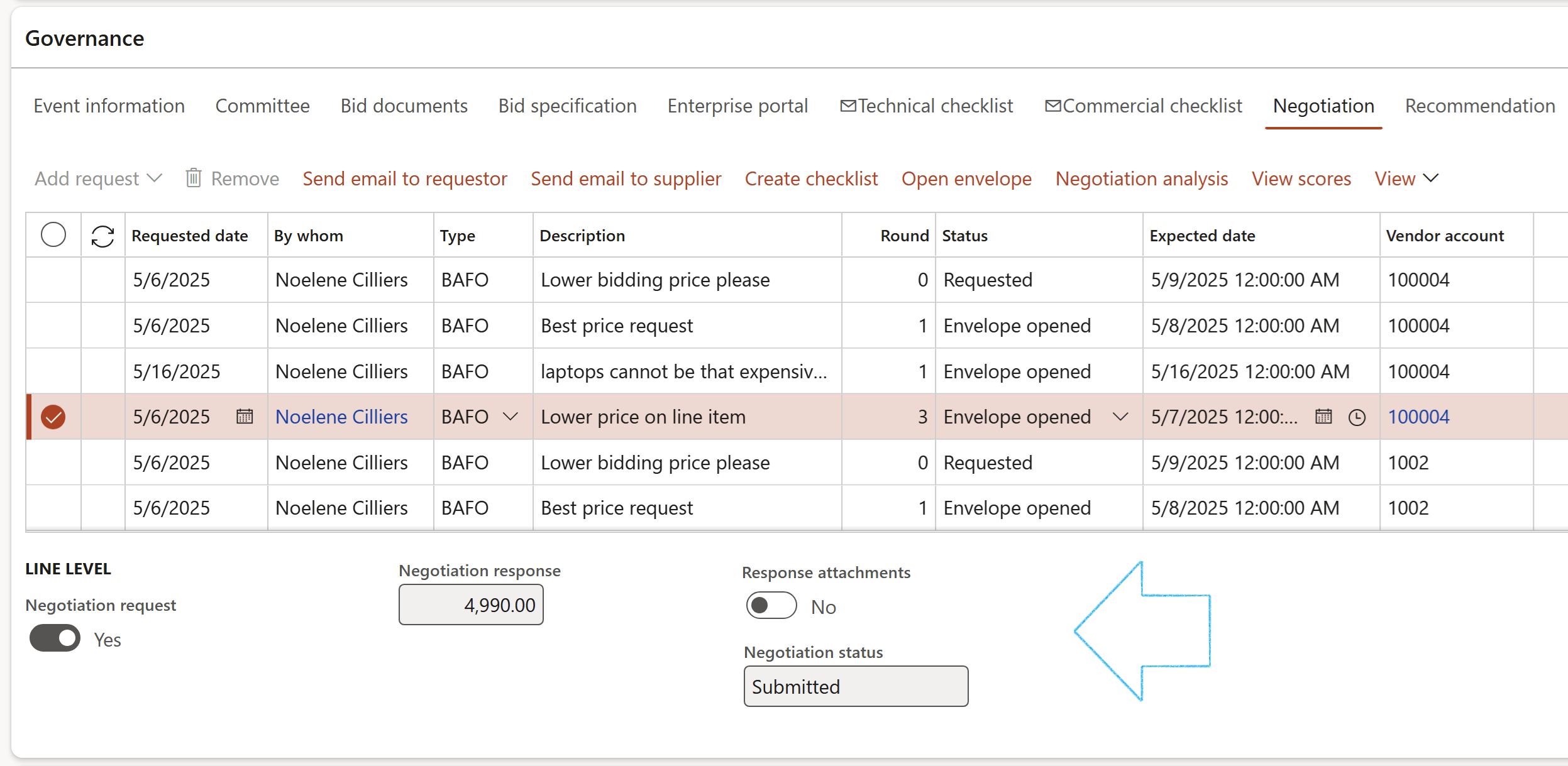

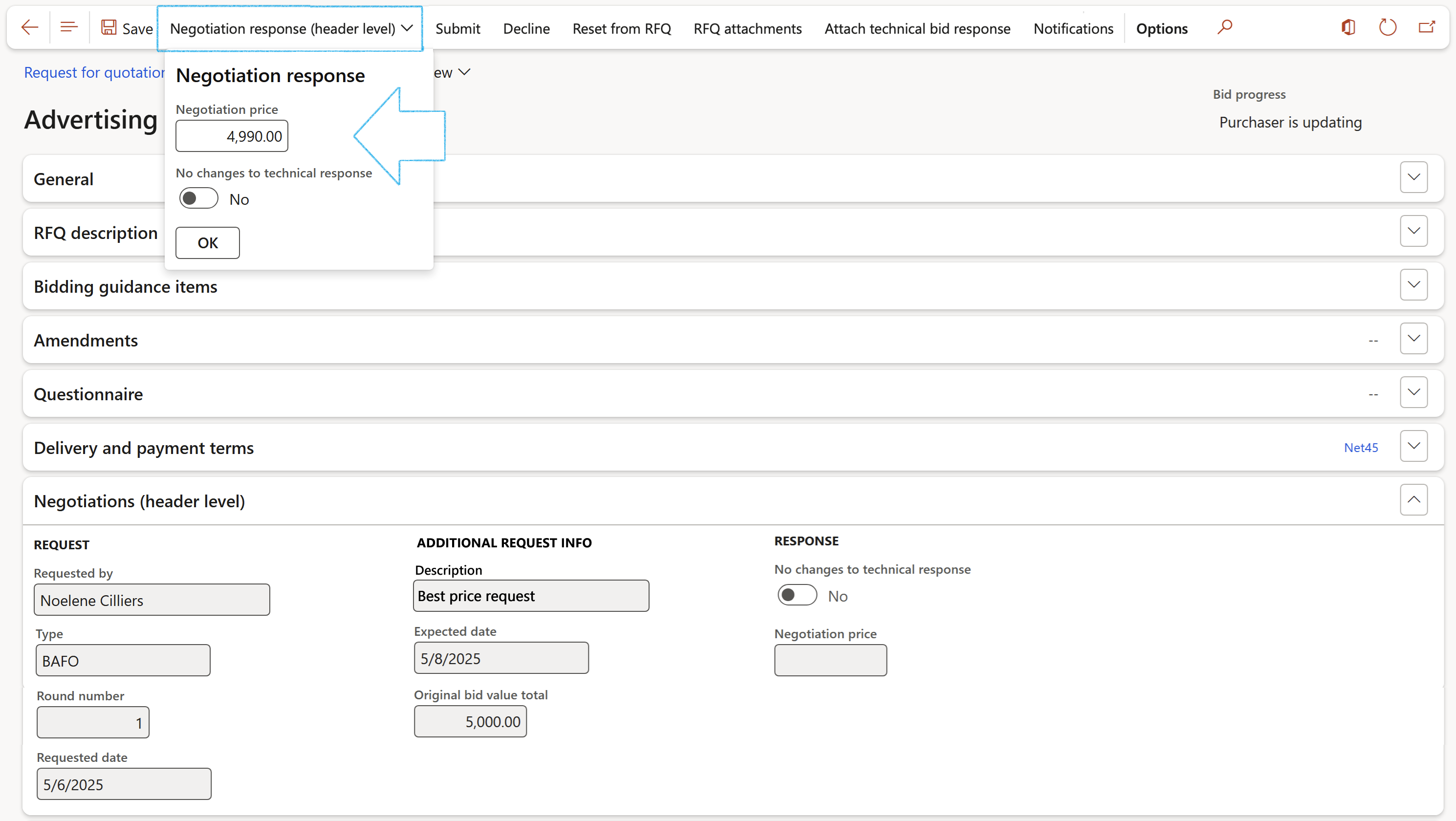

The bidder's response to the negotiation request is shown in the Vendor portal Wiki page
Go to: GRC > Governance > Tender management > All requests for quotations
The following is used to ‘force’ users to answer specific questions on the deviation or waiver of a bid:
Go to: GRC > Governance > Tender management > All requests for quotations
A warning will come up if a baseline contract does not exist on the selected solicitation type.
Go to: GRC > Governance > Tender management > All requests for quotations
Go to: GRC > Governance > Tender management > All requests for quotations
A warning will come up if a baseline contract does not exist on the selected solicitation type.
The sum of the Net amount column under the Purchase quotation lines Fast tab, will be displayed in the Net price field under the Header view, Quotation Fast tab

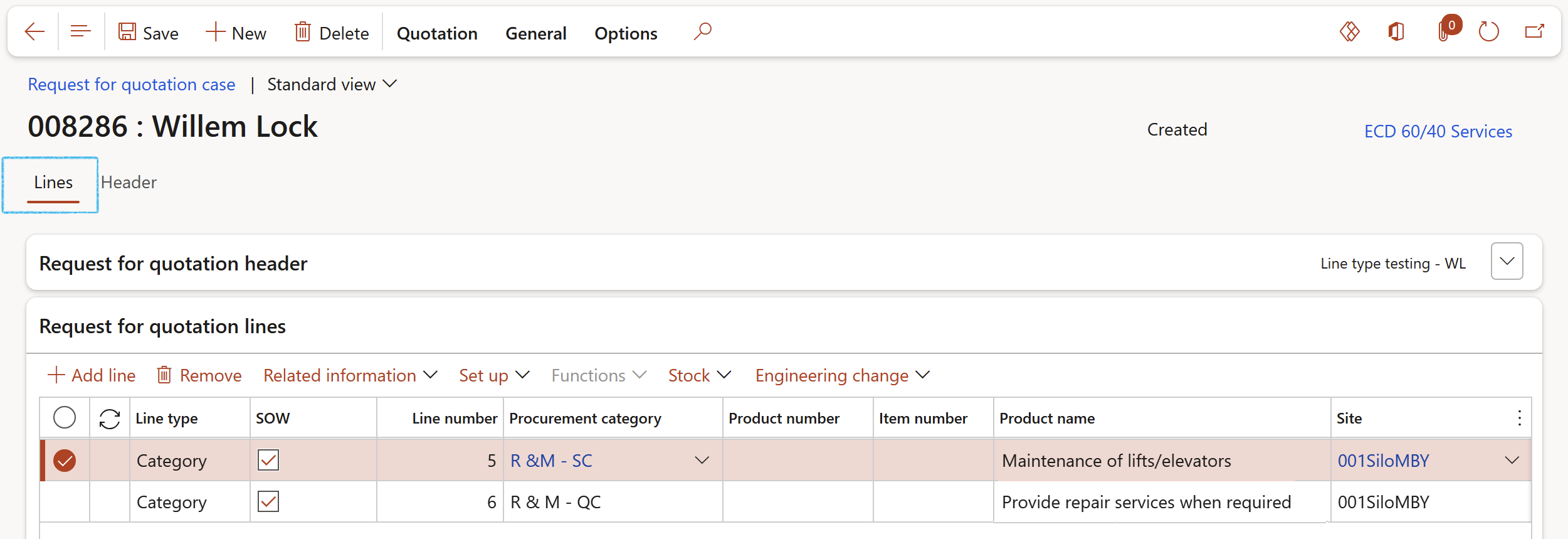

Line types on the RFQ can be Item or Category. Additionally, a Category line type can be marked as a Statement of work.
When the Accept button is clicked for an RFQ with SOW lines, the following warning will pop up:

The RFQ lines marked as SOW will be displayed on the Purchase agreement Header under the Contract administration Fast tab, and the RFQ lines that are not marked as SOW will be displayed in the Purchase agreement Lines
Purchase agreement hold days
On Awarding of the bid, the RFQ will create the purchase agreement with an effective date of Today + “10”.
The same number of days will be added to the purchase agreement expiration date.
Also on Awarding of the bid, the RFQ will create a contract.
On the RFQ header, under the Governance Fast tab, open the Contracts Index tab to view the created contract details
Users can cancel an RFQ using the status button
Go to: GRC > Governance > Tender management > All requests for quotations
If Closed is selected, a notification will pop up to warn the user that the bid will be cancelled and all vendors marked as rejected.
OR
Users can click on the Cancel button on the RFQ case.
The Sign off fast tab is primarily used to log which users did what when. It can also be used to manually add additional signing activities onto the RFQ.

The Tender evaluation report status can be changed by clicking on the TER status button, and selecting the relevant status from the dropdown list

On the RFQ header, under the General Fast tab, move the Allow due date extension slider to Yes to enable due date extension.
A request for due date extension cannot be done after the Expiration date of the RFQ
Only users that belong to the Approver committee will be allowed to approve the due date extension, if the Lock amendments slider on the Solicitation type is moved to Yes.
The original Expiration date under the General Fast tab will be replaced with the New due date selected on the dialog, and be displayed under the Amendments Fast tab.

For audit trail purposes, a record of the user that extended the due date, will be created under the Amendments Fast tab.

If the Process was selected on the Solicitation type, the Process field will be populated with the value selected on the Solicitation type. This can be edited.
The Start date and Completed date will be entered by the system when the Start and Complete buttons are clicked
The Workflow editor can only be opened in Microsoft Edge
To create workflow for Procurement plans, go to:
GRC > Setup > Governance, Risk and Compliance workflows
Below is a screenshot of the Procurement plan approval workflow
Users receive notifications to action workflow in D365
Coming soon
Coming soon
Go to: GRC > Governance > Tender management > All requests for quotations
Go to: GRC > Governance > Reports and Inquiries > Tender score summary
The Purchase agreement register tracks the current status of each Purchase agreement within your organization.
The following is displayed:
Contract number | PR number | Submitted date |
Supplier name | Supplier BEE level | Ownership structure |
Department | Tender initiation date | Total item value |
Statement of work value | Total commercial value | Commencement date |
Expiry date |
Go to: GRC > Governance > Reports and Inquiries > Purchase agreement register
This query is based on the RFQ case table (header), linked to Procurement plans and created Contracts
Go to: GRC > Governance > Reports and Inquiries > Tender register
The following is displayed:
Procurement plan number | Reference number | Planned start date year |
Supplier account | Name | Request for quotation case |
Maximum value of bid | Planned method of procurement | Bid advertisement date |
Bid closing date | Evaluation start date | Evaluation end date |
Effective date | Expiration date |

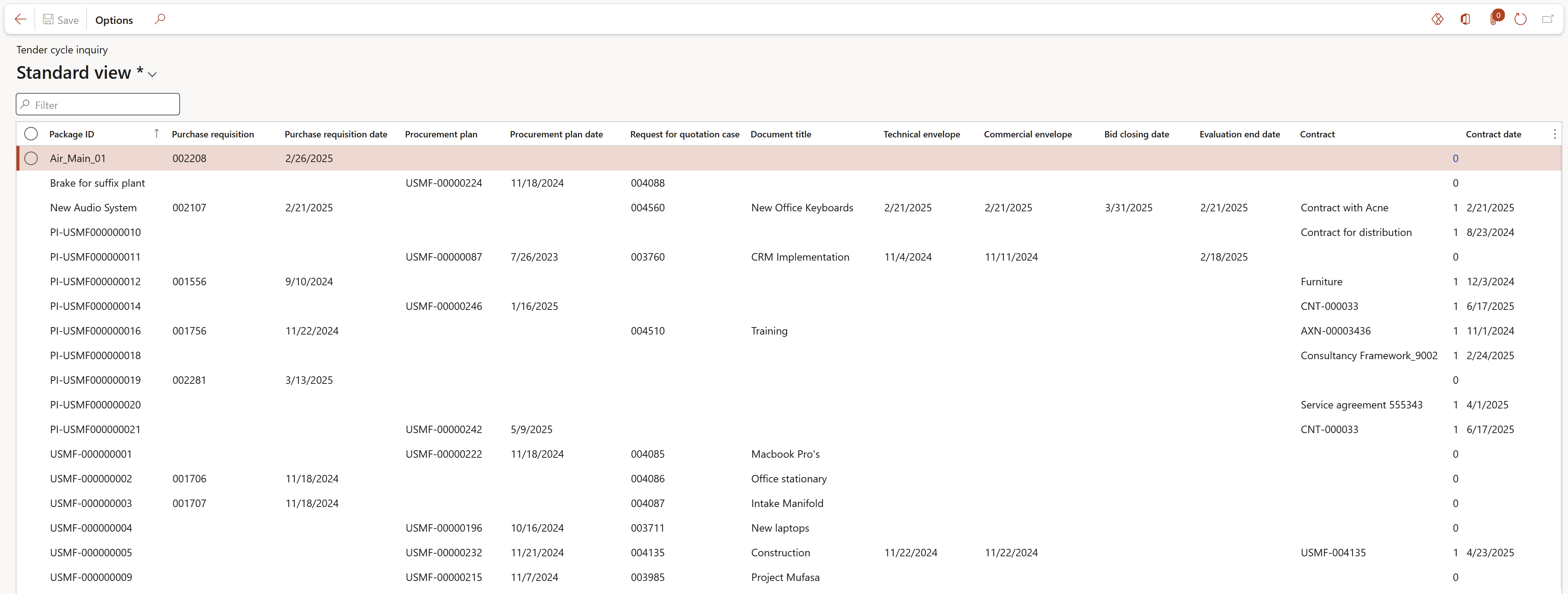

Go to: GRC > Governance > Reports and Inquiries > Tender and procurement plan dates
Go to: GRC > Governance > Reports and Inquiries > Procurement plan Gantt chart
Go to: GRC > Governance > Tender management > All procurement plans
Coming soon

Go to: GRC > Workspaces > Legal, Contracts and tender Management
Functions of the Summary tiles:
The graphs:
Use the Year filter to display specific data
Functions of the Tender related tabs:
